Hit Buyer Deadlines: SOC 2 Timeline Built on Six Phases

Ashish / CEO/Co-Founder
Hit Buyer Deadlines: SOC 2 Timeline Built on Six Phases

Hit Buyer Deadlines: SOC 2 Timeline Built on Six Phases

Type 1 audits typically finish in 3 to 6 months end to end; Type 2 audits typically take 6 to 12 months or more, driven mainly by the 3 to 6 month observation window auditors require to test operating effectiveness. Readiness work and evidence collection can be compressed with automation. The observation period cannot. That calendar constraint sets the floor for any Type 2 schedule, no matter how prepared your organization is going in.


TL;DR:

  • Automating evidence collection and mapping significantly reduces manual labor during remediation, but does not shorten the observation window required for Type 2 audits.
  • The observation period for a Type 2 report cannot be compressed or moved earlier, as it is fixed by calendar time and testing requirements.
  • Common causes of delays include missing evidence, control changes mid-observation, and slow auditor responses, which can be mitigated through proactive communication and automation.
  • Preparing and booking your auditor 2 to 3 months in advance and locking scope early are crucial for meeting your desired report date.
  • For first-time audits, shorter observation windows like three or six months can accelerate deliverables and help meet procurement deadlines.

Type 1 vs Type 2: What Each Covers and How Long They Take

A SOC 2 Type 1 report answers one question: are your controls designed appropriately as of a specific date? A Type 2 report answers a harder one: did those controls actually operate effectively over a defined period? That distinction drives almost every difference in the SOC 2 audit timeline.

Type 1 auditors examine control design at a single point in time, so fieldwork can start as soon as documentation and initial evidence are ready. Practitioner ranges put Type 1 at roughly 1 to 3 months of readiness work plus several weeks of fieldwork, landing most first Type 1 reports in the 3 to 6 month range overall.

Type 2 auditors need proof the controls worked consistently, which means they need a stretch of calendar time to sample activity across. That observation period, plus readiness and fieldwork on either side, is why a first-time Type 2 SOC 2 compliance timeline commonly runs 6 to 9 months from kickoff to final report, and sometimes stretches past 12.

Here's how the two typically break down:

  • Type 1: readiness assessment (4 to 8 weeks) plus fieldwork (2 to 4 weeks) plus report drafting (2 to 3 weeks).
  • Type 2: readiness assessment (4 to 6 weeks), remediation (variable), observation window (3, 6, or 12 months), fieldwork (2 to 4 weeks post-window), report drafting (2 to 4 weeks).

Many companies use Type 1 as a bridge. If a deal is closing in two months and your controls aren't mature enough for a full observation period, a Type 1 report satisfies the immediate procurement ask while you start the clock on Type 2. Enterprise buyers with large contract values, however, increasingly expect a Type 2 report with at least a 6 month window before they'll sign, so know your buyer's bar before you commit to a shorter timeline. Our Type 1 vs Type 2 guide walks through how to make that call for your specific sales cycle.

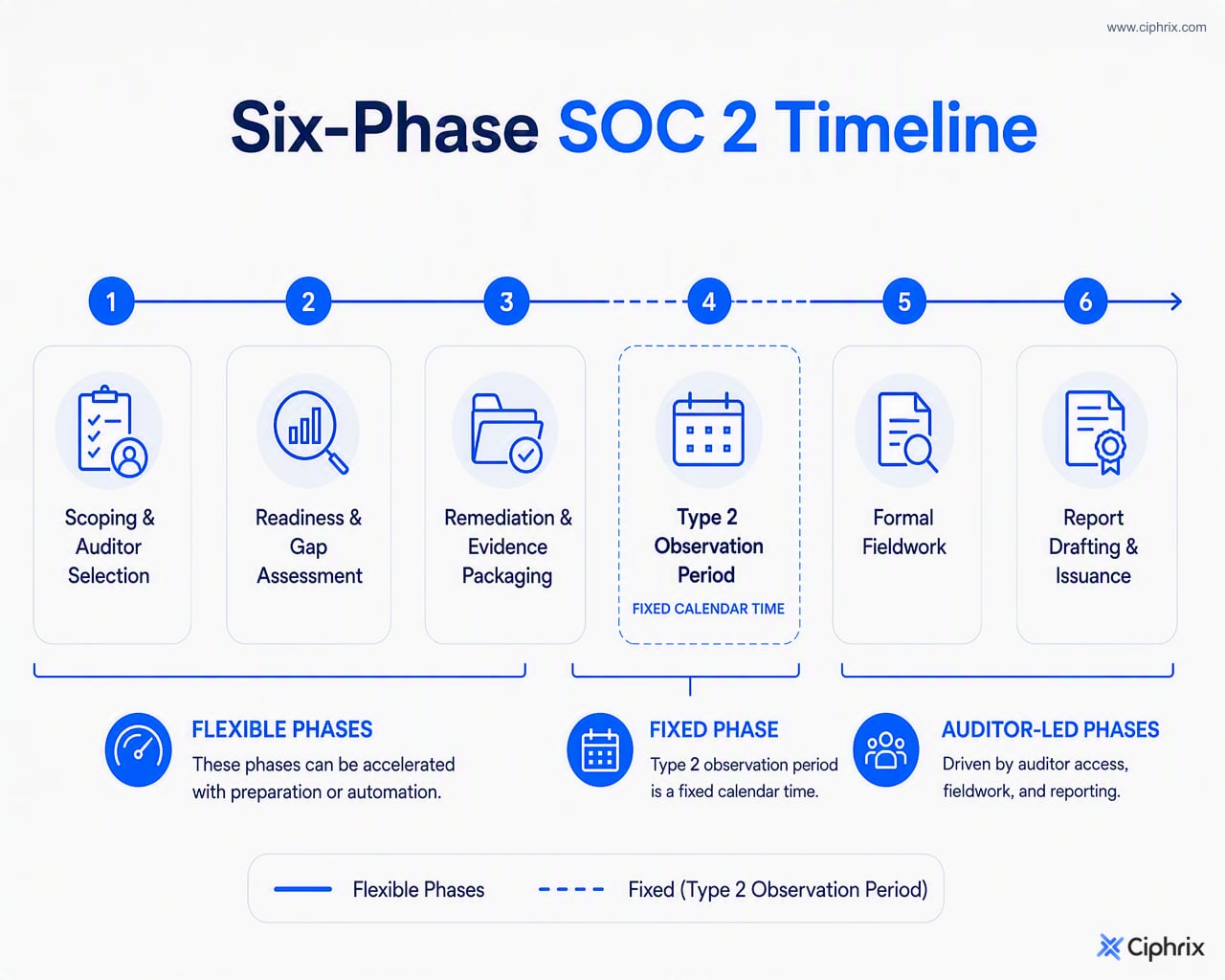

The Six Phases of a SOC 2 Audit Timeline

Every SOC 2 audit process, whether Type 1 or Type 2, moves through the same six phases. The variable is how long each phase takes and how much of that time you control.

  1. Scoping and auditor selection. Define your system boundary and select which Trust Services Criteria apply (Security is mandatory; Availability, Confidentiality, Processing Integrity, and Privacy are optional add-ons). Reserve your auditor slot now, because auditors commonly book 2 to 3 months in advance, and late outreach is one of the most common causes of missed target dates.
  2. Readiness and gap assessment. Inventory existing controls, map them to evidence sources, and identify what's missing. This runs 4 to 6 weeks for a straightforward environment, longer for organizations with sprawling infrastructure or no prior compliance program. Our readiness assessment checklist breaks this down into a repeatable process.
  3. Remediation and evidence packaging. This is where most schedule slippage happens. Implementing missing controls, standing up logging, and instrumenting automated evidence exports typically takes 4 to 16 weeks depending on how many gaps the assessment found and how much manual work is involved. A detailed evidence checklist helps teams avoid rediscovering the same gaps twice.
  4. The Type 2 observation period. This phase applies only to Type 2 reports, and it starts the day your controls go live for testing, not the day you finish implementing them. Common windows are 3, 6, or 12 months. First-time reports often use a 3 to 6 month window to accelerate delivery, then move to a full 12-month cycle on renewal once buyers have seen an initial report. Controls tested quarterly or annually inside that window (like access reviews or disaster recovery tests) need to actually occur during the window; you can't backfill them once observation closes.
  5. Formal fieldwork. Once the observation window ends (or immediately, for Type 1), the auditor tests evidence, samples control instances, and issues follow-up requests. This stage runs 6 to 10 weeks on average from kickoff to draft report, though response speed on both sides moves that number considerably.
  6. Report drafting and issuance. The auditor drafts findings, you review and respond to any exceptions, and management signs the final assertion. This typically adds 2 to 4 weeks after fieldwork closes, longer if exceptions require clarification cycles.

Pro Tip: Treat the observation period like a locked calendar block, not a task on your project plan. Everything else can flex around a delay. The observation window can't, since shortening it retroactively isn't something an auditor will sign off on.

A SOC 2 project plan template helps map these six phases against your specific target date, which matters more than any generic range once you're actually scheduling work.

How Long Does Fieldwork Actually Take?

Benchmark data gives planners something more reliable than vendor marketing copy. Across a sample of 75 SOC 2 examinations, formal fieldwork, from evidence acceptance to draft report, averaged 6 to 10 weeks. End-to-end timelines across that same sample ranged 3 to 9 months, with Type 2 and first-time examinations consistently landing at the longer end.

Benchmark snapshot: the same dataset found that 71% of examinations turned up at least one exception, and average evidence volume ran around 1,450 artifacts, with a range of roughly 400 to 4,200 depending on scope.

Scope size explains most of that spread. A startup pursuing Security-only Type 1 with a handful of cloud services might generate a few hundred artifacts and clear fieldwork in six weeks. A mid-market company adding Availability and Confidentiality criteria across a hybrid infrastructure will generate several times that evidence volume and should expect fieldwork closer to the 10-week end. An enterprise engagement covering all five Trust Services Criteria, multiple business units, and a renewal audit history often exceeds even that, mostly because of sampling across more control instances and more auditor follow-up rounds.

A few patterns hold consistently:

  • First-time audits take longer than renewals, since auditors have no prior-year baseline to reference.
  • Wider scope (more Trust Services Criteria) multiplies evidence volume, not just complexity.
  • Startups with a narrow, well-defined scope routinely beat the benchmark averages because they have fewer systems to test in the first place.

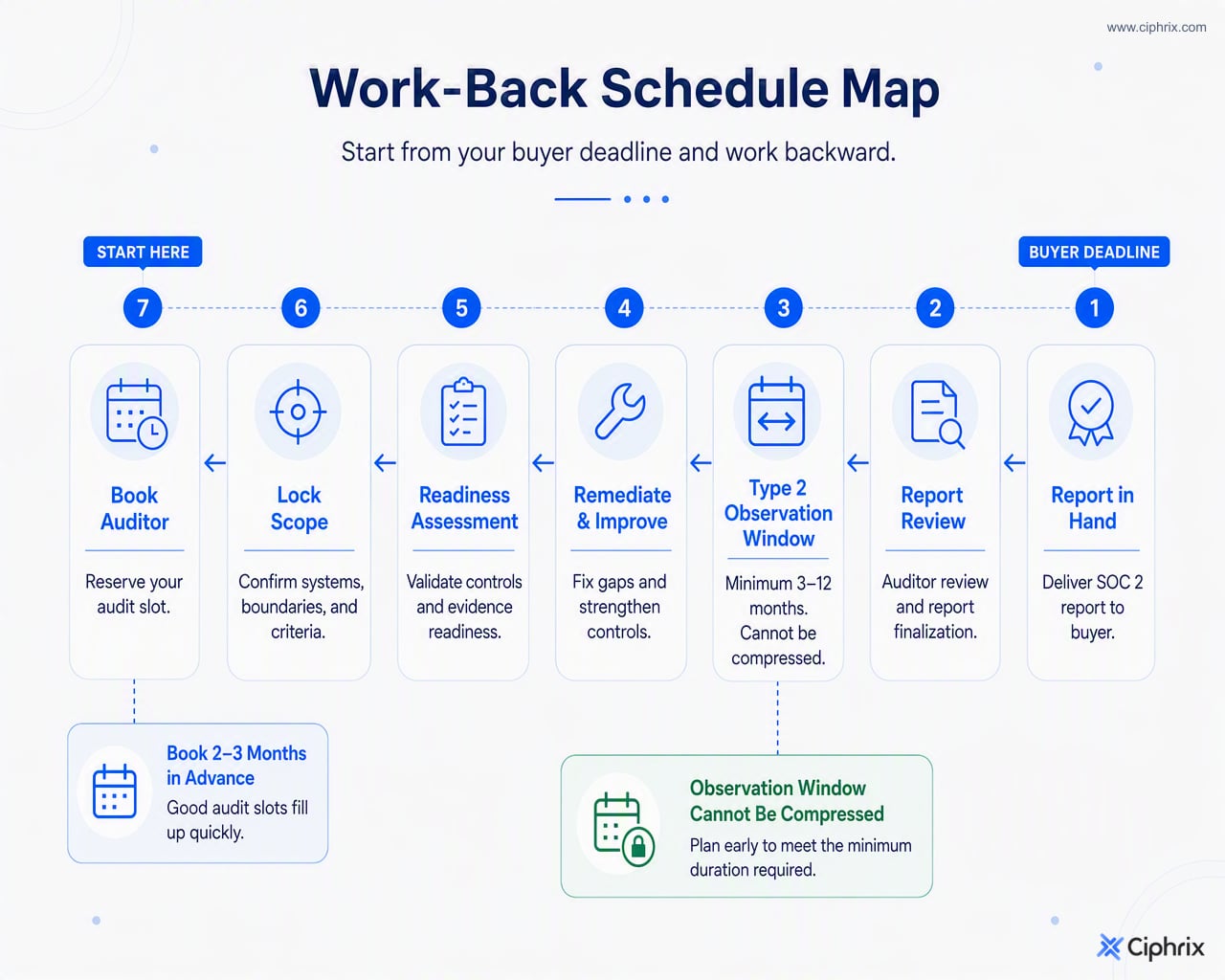

Building a Work-Back Schedule That Actually Holds

Start with the date your buyer or board needs the report in hand, then work backward. This single habit, choosing the report date first and mapping every milestone against it, is one of the strongest predictors of actually hitting a deadline rather than sliding past it.

From that target date, subtract fieldwork and report review time (6 to 10 weeks), then subtract the observation window if you're pursuing Type 2, then subtract remediation and readiness. Whatever's left is your deadline for locking scope and contacting an auditor. Given that auditors book 2 to 3 months out, that outreach needs to happen early, often before remediation work is even finished.

Not every phase has to run in sequence. Policy drafting, control automation setup, and vendor questionnaire responses can overlap with early remediation work if you coordinate it with your auditor in advance. The observation window is the one phase that can't be compressed or run concurrently with anything upstream of it.

A one-page milestone checklist for your project plan:

  • Lock target report date and confirm buyer's minimum acceptable observation length.
  • Contact and book auditor 2 to 3 months before observation start.
  • Finalize scope and Trust Services Criteria before readiness assessment begins.
  • Complete remediation before the observation window opens, not during it.
  • Schedule fieldwork kickoff immediately after observation closes.

Pro Tip: If your buyer will accept a 3-month observation window for a first report, take it. You can move to a 12-month cycle on renewal once trust is established, and the shorter first window gets you a signed contract months sooner.

What Usually Causes Delays, and How to Prevent Them

Most schedule slips trace back to a handful of repeat offenders. Missing or unsampleable evidence is the biggest one: an auditor asks for proof a control ran on a specific date, and nobody captured it. Control changes mid-observation window are a close second, since altering a control partway through testing often forces auditors to issue a bridge letter or extend observation for that specific control. Slow auditor response times and auditor capacity bottlenecks round out the list.

Mitigations that consistently work:

  • Automate evidence collection so exports happen on a schedule, not when someone remembers.
  • Run a mock fieldwork pass before the real one to surface gaps early.
  • Assign a dedicated evidence owner instead of splitting responsibility across teams.
  • Agree on response-time SLAs with your auditor before fieldwork starts.
  • Communicate proactively with buyers if an exception requires a bridge letter, rather than letting them discover it in the final report.

If internal capacity is the real constraint, bringing in outside help earlier is usually cheaper than absorbing a multi-month slip.

Where Automation Helps and Where It Can't

Automation shortens the phases that involve manual labor: drafting policies, mapping controls to evidence, filling out vendor security questionnaires, and pulling recurring evidence exports on schedule. What it cannot do is compress the observation window itself. Automation reduces the manual burden of collecting evidence, but the calendar time an auditor needs to sample activity across a period is fixed by the report type you choose, not by how fast your tooling runs.

The realistic gain from automation isn't a shorter audit. It's a cleaner, faster-to-review evidence package that lets your auditor move through fieldwork without waiting on you.

For procurement teams, that distinction matters practically: document every automated evidence output with a timestamp and source system, since that's exactly what speeds up an auditor's sampling process during fieldwork. Ciphrix's readiness automation is built around that same principle, tightening the phases you control while being upfront about the phase you don't.

How Ciphrix Fits Into Your SOC 2 Timeline

If remediation and evidence packaging are the phases eating your schedule, that's exactly where automation earns its keep. Ciphrix's compliance platform generates audit-ready policies, maps controls to evidence automatically, and handles vendor questionnaire responses that otherwise consume weeks of compliance-team time. The result isn't a shorter observation window. It's fewer weeks lost to manual evidence hunting before fieldwork even starts, and a cleaner package when your auditor does show up.

For teams working against a procurement deadline, that means faster readiness, fewer exceptions during fieldwork, and less time spent chasing down artifacts across disconnected systems. If you're mapping your own SOC 2 timeline right now, a readiness assessment with Ciphrix is a reasonable next step to see exactly where your gaps sit before you book an auditor. It won't change how long a Type 2 observation period has to run. It will change how ready you are the day that window opens.
