The short answer: how long SOC 2 takes for a startup
For a startup, SOC 2 timing depends less on company size and more on readiness, report type, buyer requirements, and auditor scheduling. A Type 1 report can move faster because it evaluates control suitability at a specified date. A Type 2 report takes longer because it also evaluates whether relevant controls operated effectively over a defined period, according to the AICPA & CIMA SOC suite description.
Use these as planning ranges, not guarantees:
| Path | Realistic planning answer | Why |
|---|---|---|
| Type 1, mature startup | Several weeks to ~2 months | Controls, policies, owners, and evidence already exist; audit scheduling is available. |
| Type 1, first-time startup | ~2–4 months | Readiness and remediation usually happen before audit work. |
| Type 2, controls already operating | Reporting period + post-period audit/report time | The operating period still has to be covered, even if preparation is done. |
| Type 2, first-time startup | Commonly a several-month project | Readiness, remediation, the report period, audit work, and issuance all add elapsed time. |
| Type 2, deadline-driven from scratch | Risky under 180 days | A short deadline leaves little room for remediation, evidence collection, and post-period review. |
The important distinction: the audit itself is not the whole project, total elapsed time includes scoping, readiness, remediation, the Type 2 reporting period where applicable, auditor review, and report issuance. RSM notes that total SOC reporting time includes preparation, remediation, the report period, audit work, and issuance; in one RSM delivery model, reports are normally issued 45–60 days after the report end date, but that is not a universal industry SLA.
SOC 2 startup timeline planner: best-case, typical, and delayed scenarios
The table below is editorial planning guidance for startup backplanning. It is not an AICPA rule, auditor commitment, or universal market benchmark.
| Report type | Startup readiness level | Realistic elapsed planning range | Major assumptions | Main delay risk |
|---|---|---|---|---|
| Type 1 | Best case | Several weeks to ~2 months | Scope is narrow and stable; policies, access controls, asset inventory, vendor process, change management, and evidence are already in place; auditor availability is confirmed. | Evidence exists but is incomplete, inconsistent, or not tied to the selected scope. |
| Type 1 | Typical first-time startup | ~2–4 months | Readiness assessment finds gaps; team remediates before audit review; control owners can respond quickly. | Remediation takes longer than expected because controls were informal or undocumented. |
| Type 1 | Delayed | 4+ months | Scope changes, ownership is unclear, or foundational controls are missing. | The company tries to audit before the control environment is defined. |
| Type 2 | Best case | Defined report period + audit/report issuance | Controls are already operating before the period starts; evidence is being captured consistently; scope and auditor schedule are fixed. | Assuming “we started the project” means “the Type 2 period has valid evidence.” |
| Type 2 | Typical first-time startup | Several months, often planned around a 180+ day window | Readiness, remediation, report period, fieldwork, and issuance all need to be sequenced. | Material gaps delay the start of the report period. |
| Type 2 | Delayed | Longer than the initial plan | Scope expands, evidence is weak, control owners are unavailable, tooling is misconfigured, or auditor timing shifts. | The startup begins with an optimistic deadline instead of a readiness-based plan. |
A 90-day Type 2 report should be treated carefully. A Type 2 report covers a defined period, and the appropriate period should be agreed with the auditor while considering contractual requirements and whether the organisation can demonstrate that controls operated during that window, as explained by the Cloud Security Alliance. A three-month period may be used in practice, but it is not a universal AICPA minimum and does not mean a startup can complete readiness, remediation, the reporting period, fieldwork, and issuance inside 90 calendar days from scratch, basically.

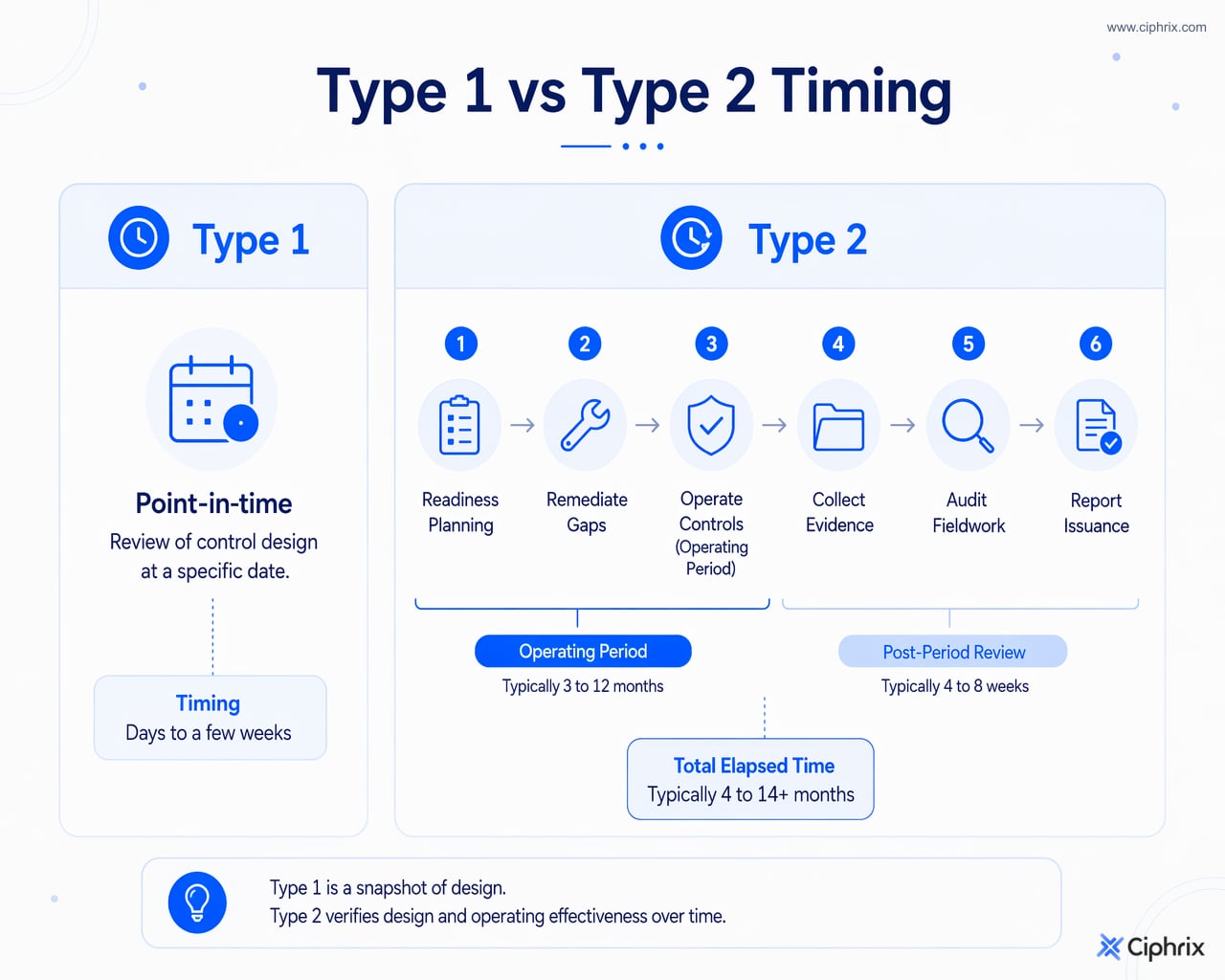

Why Type 1 and Type 2 timelines are different
The timing difference comes from what each report covers.
A SOC 2 Type 1 report evaluates whether controls are suitably designed at a specified date. The faster path when the startup already has the right controls and evidence in place.
A SOC 2 Type 2 report also evaluates whether relevant controls operated effectively over a defined period. That means the company needs time for controls to run, evidence to accumulate, and exceptions to be handled.
This is why Type 1 can sometimes serve as an interim assurance artifact while a company prepares for Type 2. But whether that is acceptable depends on the buyer, contract, and procurement process. Do not assume a Type 1 report, auditor engagement, readiness output, or security packet will satisfy a customer that asked specifically for Type 2.

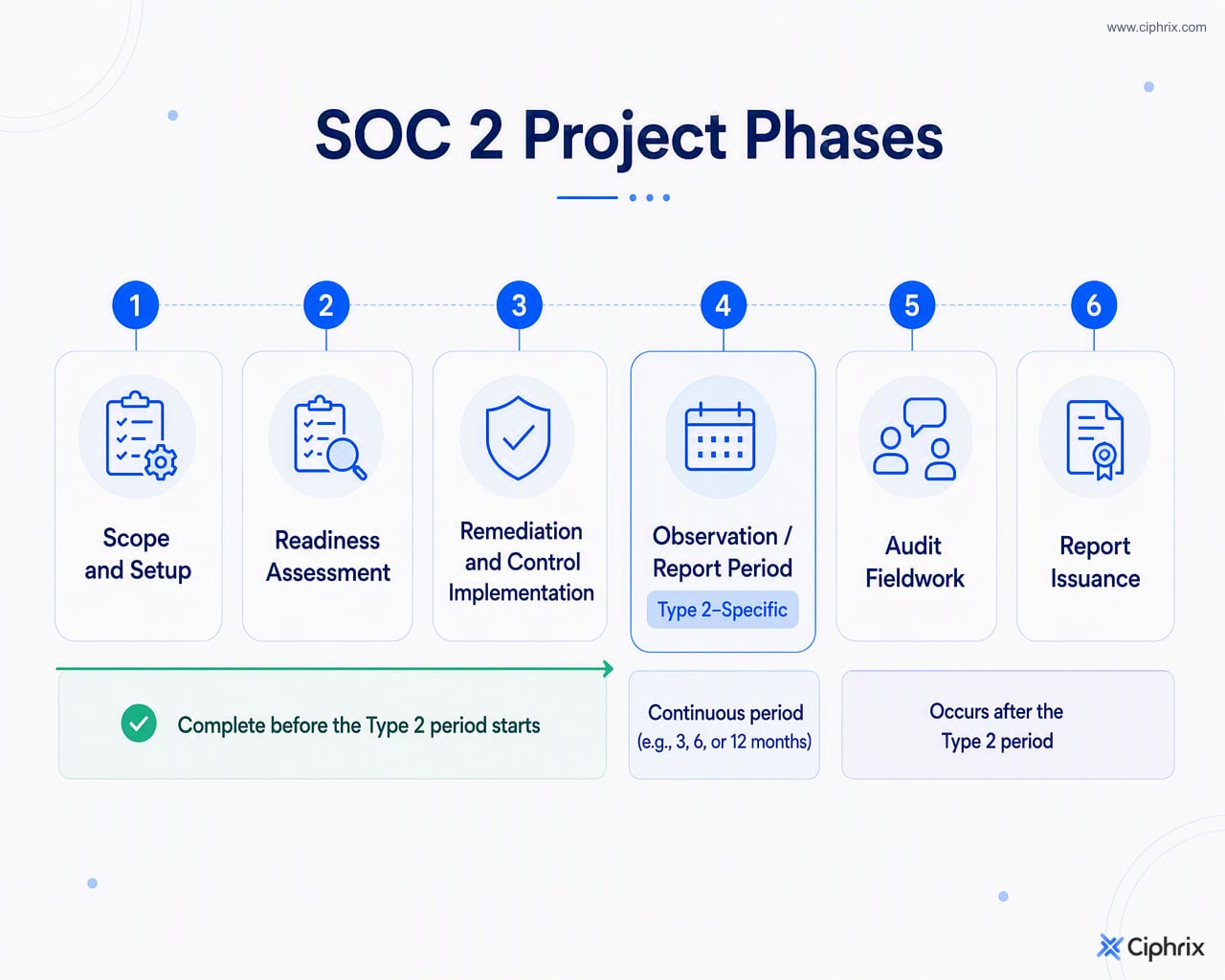

What actually happens during the SOC 2 timeline
Starting a SOC 2 project is still not the same as starting a Type 2 reporting period. Preparation should happen first. RSM recommends completing readiness work and remediating material gaps before beginning a Type 2 report period, so controls can operate and generate evidence throughout that period.
-
Scope and setup
The startup chooses Type 1 or Type 2, defines the system boundary, identifies relevant teams and locations, selects the Trust Services Criteria, and aligns with an auditor. SOC 2 examinations use applicable AICPA Trust Services Criteria covering Security and, where selected as applicable, Availability, Processing Integrity, Confidentiality, and Privacy. Broader criteria may still add scoping and evidence work depending on the organisation. -
Readiness assessment
The company identifies current controls, policies, owners, systems of record, and evidence sources. This phase often reveals whether the desired timeline is still realistic. -
Remediation and control implementation
Missing or informal controls are fixed before audit reliance. Examples include access review routines, onboarding and offboarding evidence, change approvals, vendor review records, incident response process, logging coverage, and risk management documentation. -
Observation or report period
For Type 2, controls must operate over the defined period. Evidence needs to be captured consistently during that window, not reconstructed after the fact. -
Audit fieldwork
The auditor reviews evidence, asks follow-up questions, tests controls, and evaluates exceptions. The duration depends on scope, evidence quality, responsiveness, and auditor process. -
Report issuance
After fieldwork, the report goes through review and finalisation. This post-period stage is still part of elapsed time, even though many startups forget to include it in deadline planning.

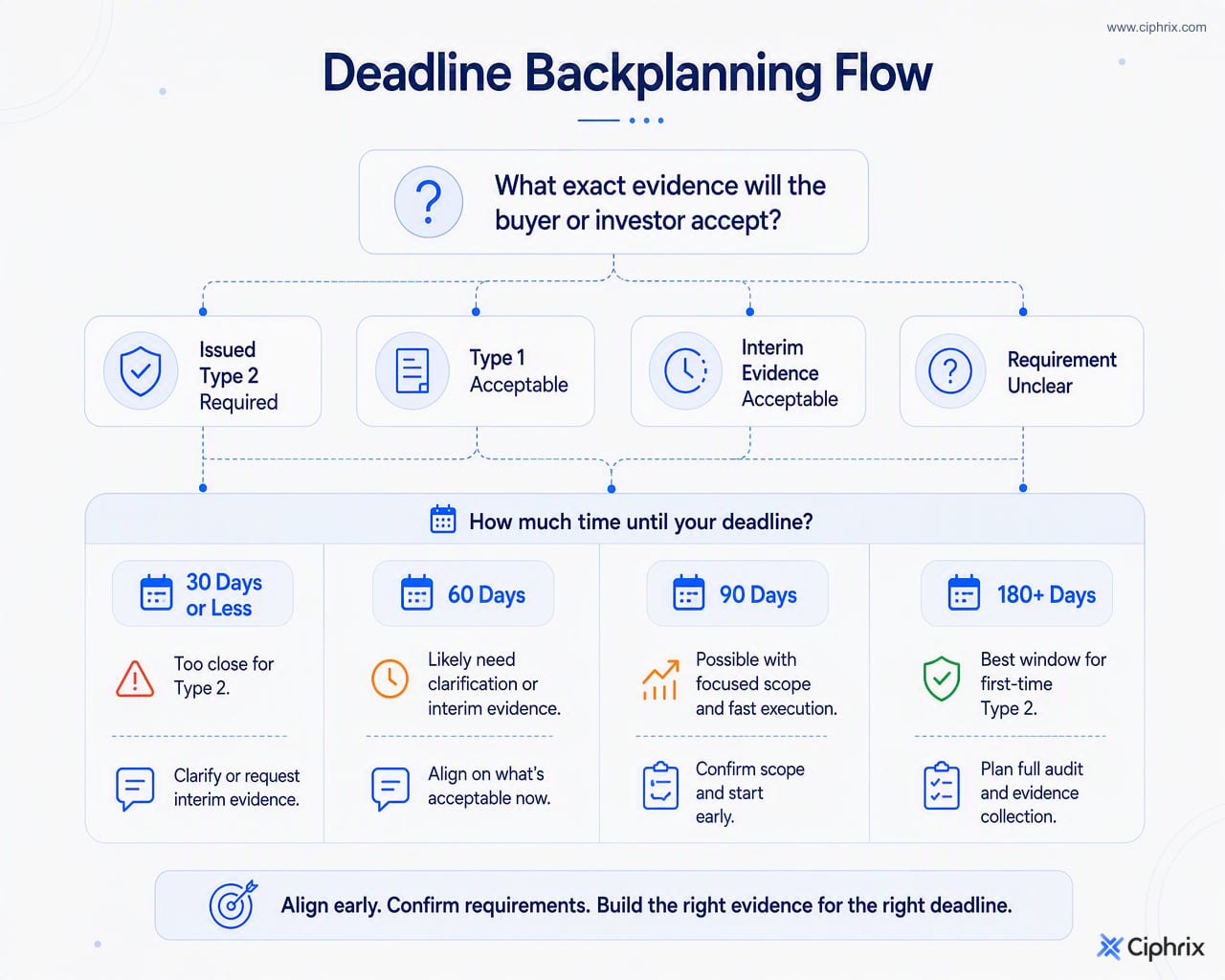

How to backplan from a customer or fundraising deadline
Ask first: “What exact evidence will the buyer or investor accept by the deadline?” The answer may be Type 2 only, Type 1, evidence that an audit is in progress, a readiness assessment, a security packet, or a dated remediation plan. Acceptance is buyer- and contract-dependent.
| Deadline | Realistic option to discuss | What must already be true | What to tell the buyer or procurement team | Main risk |
|---|---|---|---|---|
| 30 days | Clarify requirement; provide security packet, readiness status, auditor engagement status, or scoped remediation plan if acceptable. Type 1 only if already highly mature and auditor timing works. | Controls and evidence are already organised, or the buyer accepts interim materials. | “We are confirming the report path and can share current security evidence and timeline commitments subject to your acceptance.” | Promising a report before scope, evidence, or auditor availability is confirmed. |
| 60 days | Possible Type 1 path for a mature startup; readiness plus remediation plan for others. Type 2 report from scratch is unlikely. | Narrow scope, existing controls, available owners, and fast evidence retrieval. | “We can pursue Type 1 or provide in-progress evidence while planning Type 2, depending on what you require.” | Readiness gaps consume the whole window. |
| 90 days | Readiness plus start of a Type 2 period may be realistic; Type 1 may be possible depending on maturity. Full Type 2 completion needs careful auditor confirmation. | Controls are already operating or remediation is minimal; report period and issuance schedule are agreed. | “We need to confirm whether you require an issued Type 2 report or will accept interim evidence during the Type 2 process.” | Treating a 90-day period as enough for the entire project lifecycle. |
| 180+ days | More realistic window for first-time Type 2 planning. | Scope is disciplined, owners are available, remediation starts early, and evidence routines are operating before the period begins. | “We can provide a dated plan, confirm the intended report path, and share progress milestones.” | Scope expansion or weak evidence delays the report period. |
If the deadline is tied to a live deal, do not guess what procurement will accept. Get the requirement in writing, including report type, report period expectations, system scope, and whether interim evidence is acceptable.
What makes SOC 2 faster or slower for startups
Security maturity is basically the biggest practical driver. A startup with documented access controls, change management, vendor reviews, incident response, risk management, asset inventory, and logging routines is planning a different project from a startup creating those processes for the first time.
Scope affects complexity. A narrow, defensible system boundary is easier to coordinate than an unclear boundary that pulls in extra products, infrastructure, teams, or data flows. Additional Trust Services Criteria may add scoping and evidence work, depending on the systems and controls involved.
Evidence readiness matters more than policy volume. A policy says what should happen; audit evidence shows whether the control was designed or operated as described. For Type 2, evidence has to exist across the defined period.
Team availability can make or break the plan. Founders, engineering, IT, security, HR, finance, and operations may all own pieces of evidence. If those owners are unavailable, even a well-scoped audit can stall.
Auditor scheduling should be confirmed early. A startup can be internally ready and still miss a deadline if the engagement, fieldwork window, or report review timing is not aligned.
Existing tooling can support evidence collection and coordination when systems are configured well. Identity providers, cloud platforms, ticketing systems, HR systems, code repositories, and vendor management records can all become evidence sources. Tooling does not remove the need for control ownership or auditor review.
Remediation depth determines whether the Type 2 period can start. If material gaps remain, starting the period early may create exceptions or unusable evidence rather than a faster report.
Should a startup get Type 1 first or go straight to Type 2?
Type 1 may make sense when the startup needs a near-term independent assurance artifact, the buyer is willing to consider it as interim evidence, and controls are designed but have not yet operated over a sufficient period for Type 2. It can create a bridge while the company prepares for a Type 2 period.
Going straight to Type 2 may make more sense when the buyer specifically requires Type 2, the startup has enough runway before the deadline, and controls are already operating with evidence being captured. This avoids treating Type 1 as a temporary detour.
The trade-off is timing versus assurance period. Type 1 can be faster because it is point-in-time — or, more exactly, because the review is point-in-time. Type 2 provides evidence over a defined operating period, but it requires more elapsed time. Starting Type 2 before controls are ready can waste time if evidence is missing, inconsistent, or outside scope.
If your SOC 2 deadline is too close, what should you do?
First, get clear on the exact requirement. Ask whether the customer needs an issued Type 2 report, a Type 1 report, proof of auditor engagement, an in-progress audit status, a completed readiness assessment, a security questionnaire, or a remediation plan.
Then reduce timeline risk:
- Define the system scope narrowly but defensibly.
- Complete a readiness assessment before committing to a Type 2 period.
- Prioritise gaps that block audit readiness.
- Assign control owners and evidence sources.
- Confirm auditor availability and expected report timing.
- Create a buyer communication plan with dates, scope, and dependencies.
- Avoid starting a Type 2 period before controls are ready to operate and generate evidence.
Ciphrix can support this planning work by helping startups assess readiness, organise control ownership, and move evidence collection from a deadline scramble into a steadier operating rhythm. It does not replace the auditor’s judgement or make SOC 2 instant, but it can help teams understand what needs to be true before they commit to a timeline.
The practical answer is simple: choose the report path based on readiness, deadline, and what the buyer will actually accept. If the deadline is close, check the acceptance criteria first, then backplan from the evidence you can credibly produce.
