ISO 27001 Risk Assessment: A Practical Audit-Ready Guide

Ashish / CEO/Co-Founder
ISO 27001 Risk Assessment: A Practical Audit-Ready Guide

An ISO 27001 risk assessment is the documented, auditable process by which an organization identifies information-security risks, analyzes their likelihood and potential impact, evaluates them against defined acceptance criteria, and records the treatment decisions that justify every control selected in the Statement of Applicability (SoA). Under ISO/IEC 27001:2022 Clauses 6.1.2 and 8.2, this process is mandatory, and the outputs must be retained as documented information that an auditor can sample at any time.

The minimum auditable output set: a risk register with inherent and residual ratings, named risk owners, documented treatment decisions, cross-references to Annex A controls, and a completed SoA with justifications for inclusion or exclusion of every control.

Before your next audit, confirm you can produce each of the following:

  • A written risk assessment methodology (scope, scales, aggregation formula, and acceptance criteria)
  • A risk register with at minimum: risk ID, asset, threat, vulnerability, risk owner, inherent rating, existing controls, residual rating, treatment decision, and review date
  • Treatment decisions approved by named owners and traceable to specific Annex A controls
  • A completed SoA that maps every Annex A control to a justification and references the risk(s) that drove the selection
  • Evidence of at least one formal review cycle, including the date and approver

These five items represent the floor. Auditors will sample all of them, and a gap in any one is a nonconformity finding.

What Clauses 6.1.2 and 8.2 of ISO/IEC 27001:2022 actually require

ISO/IEC 27001:2022 is a risk-based standard, it is not a prescriptive checklist. Controls must be selected and justified by the organization's specific risk profile. An auditor who finds controls adopted from an industry template, with no documented link to assessed risks, will raise a finding regardless of how thorough the control implementation appears.

Clause 6.1.2 sets the planning-stage requirements. The organization must define risk criteria (what constitutes an acceptable risk level), establish a process that produces consistent and comparable results across assessors and over time, identify risks and assign a named owner to each, analyze the likelihood and consequence of each risk, and evaluate risks against the acceptance criteria to determine which require treatment. Clause 6.1.3 then requires the organization to select appropriate treatment options and map chosen controls to Annex A, producing the SoA with documented justifications.

Clause 8.2 operationalizes those planning requirements. It mandates that the risk assessment process be performed at planned intervals and whenever significant changes occur, and that documented results be retained. The phrase "planned intervals" is not defined numerically by the standard; the organization sets the cadence and must be able to demonstrate it was followed.

What auditors sample: the documented methodology, the risk register (inherent and residual values, owners, treatment decisions), the SoA (control justifications and cross-references), and review logs showing the assessment was repeated on schedule and after material changes.

The 2022 revision of the standard consolidated Annex A from 114 controls across 14 domains into 93 controls across four themes (organizational, people, physical, and technological). This restructuring affects how organizations map risks to controls in the SoA. Any organization that certified under the 2013 version and has not updated its SoA mapping to reflect the 2022 Annex A structure carries a gap that auditors will find.

Risk registers must be treated as living documents reviewed at planned intervals, typically with a full annual review, lighter quarterly updates, and ad-hoc reviews triggered by incidents or major changes such as new cloud deployments, acquisitions, or significant personnel changes.

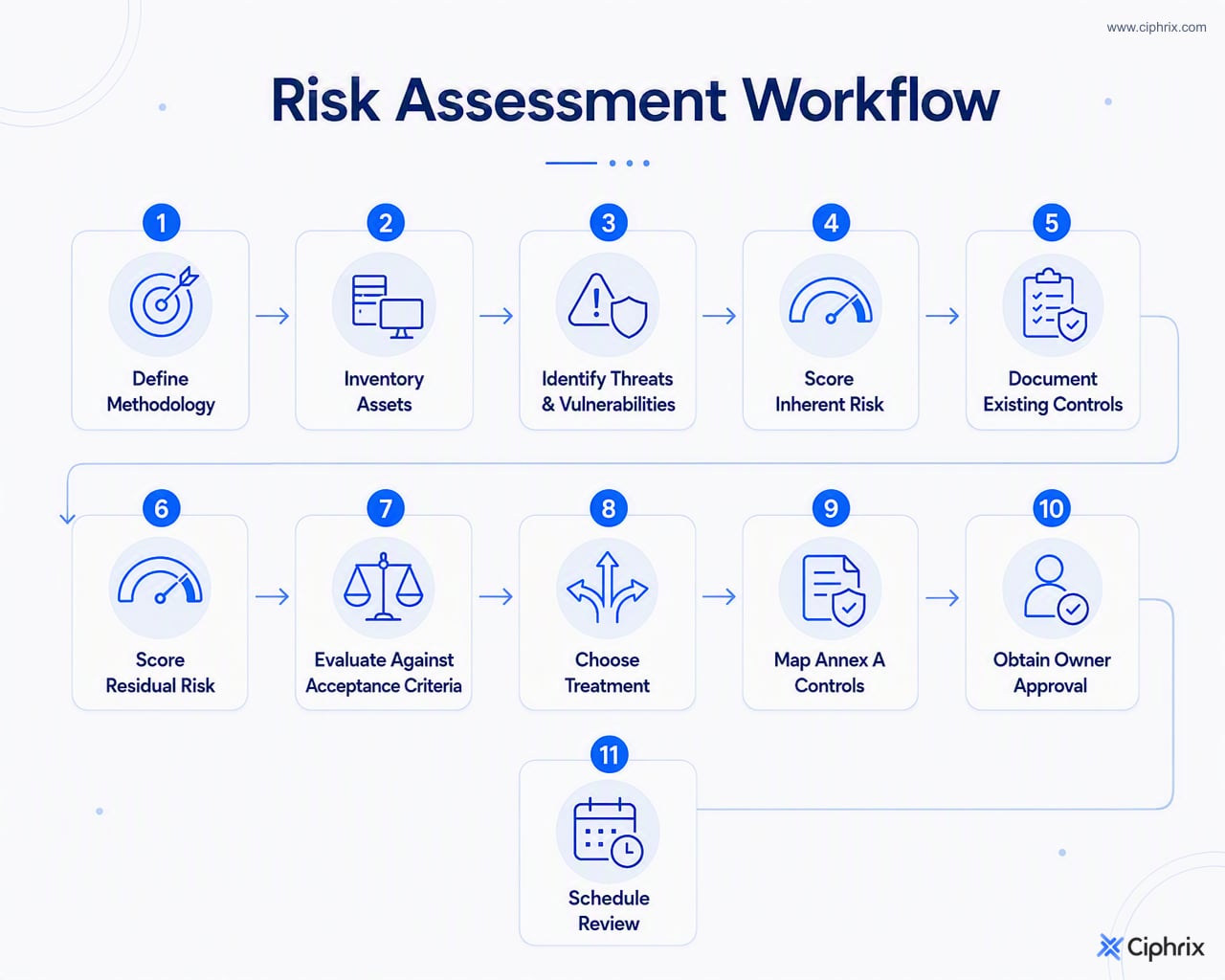

How to run a step-by-step ISO 27001 risk assessment and produce a defensible register

Effective risk analyses follow four core steps: identify assets and threats, score likelihood and impact, decide on treatment, and document and review. The expanded process below adds the pre-work and governance steps that make those four stages auditable.

Pre-work: define before you assess

Before scoring a single risk, the organization must document its methodology. This includes the ISMS scope, the risk criteria (acceptance threshold), the likelihood and impact scales, the aggregation formula (for example, likelihood × impact = risk rating), and the roles responsible for each step. Without this foundation, two assessors working independently will produce inconsistent scores, and an auditor will note the discrepancy.

The assessment process

  1. Asset inventory. Catalog information assets within scope: data stores, systems, applications, processes, and supporting infrastructure. Assign an asset owner to each.
  2. Threat and vulnerability identification. For each asset, identify plausible threats (unauthorized access, ransomware, insider misuse, physical theft) and the vulnerabilities those threats could exploit (unpatched software, weak access controls, inadequate backup). Human factors such as phishing and social engineering consistently surface as high-priority risks and should be treated as a distinct risk category, not an afterthought.
  3. Likelihood and impact scoring. Apply the defined scales to each asset-threat-vulnerability combination. Score inherent likelihood (before controls) and inherent impact, then calculate the inherent risk rating using defined scales.
  4. Existing controls assessment. Document controls already in place for each risk. This step produces the residual likelihood and residual impact scores, and therefore the residual risk rating.
  5. Risk evaluation. Compare each residual risk rating against the acceptance criteria. Risks above the acceptance threshold require a treatment decision; those at or below it may be accepted.
  6. Treatment decision. For each risk above the threshold, select one of the four treatment options (modify, retain, avoid, or share) and identify the specific Annex A controls that will be applied.
  7. SoA mapping. Record the selected controls in the SoA with justifications. Controls not selected must also appear in the SoA with a documented reason for exclusion.
  8. Owner sign-off and review scheduling. Obtain approval from the named risk owner for each treatment decision and record the next scheduled review date.

Minimum risk register fields

A defensible risk register must include the following fields at minimum:

FieldDescription
Risk IDUnique identifier for traceability across documents
AssetThe information asset or process at risk
ThreatThe event or action that could cause harm
VulnerabilityThe weakness the threat exploits
Risk OwnerNamed individual accountable for the treatment decision
Inherent LikelihoodScore before existing controls are applied
Inherent ImpactScore before existing controls are applied
Inherent Risk RatingAggregated score (e.g., likelihood × impact)
Existing ControlsControls currently in place
Residual LikelihoodScore after existing controls
Residual ImpactScore after existing controls
Residual Risk RatingAggregated residual score
Treatment DecisionModify / Retain / Avoid / Share
Annex A ControlsControl IDs selected to treat the risk
SoA ReferenceCross-reference to the SoA entry
Review DateNext scheduled reassessment date
StatusOpen / In Progress / Closed

Pro Tip: Document your aggregation formula (for example, likelihood × consequence = risk rating) and your scale definitions before the first assessment session. Without this, two assessors working the same risk will produce different scores, and an auditor reviewing the register will flag the inconsistency as a methodology deficiency.

Choosing a methodology: qualitative, quantitative, or hybrid

ISO 27001 does not mandate a specific assessment methodology. The standard requires only that the chosen method be documented and produce consistent, comparable results. The three primary approaches each carry distinct trade-offs.

Qualitative methodology uses descriptive categories for likelihood (Rare, Unlikely, Possible, Likely, Almost Certain) and impact (Negligible, Minor, Moderate, Major, Severe), mapped to a numeric matrix. Practical for most organizations because it requires no actuarial data, is faster to apply across a broad asset inventory, and produces results that non-technical stakeholders can interpret. The limitation is that two assessors may assign different categories to the same scenario, so the methodology document must include clear definitions and worked examples for each scale level.

Quantitative methodology expresses likelihood as a probability and impact in monetary terms, producing an annualized loss expectancy (ALE). This approach is defensible and precise for high-value assets where actuarial or loss data exists, such as financial systems or regulated healthcare data. For most SMBs and cloud-native SaaS organizations, the data required to support a credible quantitative model is not available, and a poorly calibrated monetary model is harder to defend to an auditor than a well-documented qualitative one.

Hybrid methodology applies qualitative scoring across the full asset inventory and reserves quantitative analysis for the highest-rated risks or the most business-critical assets. This is the approach most commonly seen in mid-market and regulated-sector organizations. A balance between coverage speed and analytical depth where it matters most.

For organizations in regulated healthcare or financial services, a hybrid approach with quantitative analysis for Tier 1 assets is generally the most defensible choice. For startups and SMBs pursuing initial certification, a well-documented qualitative approach is sufficient and far more achievable within a realistic project timeline.

Pro Tip: Whatever methodology you select, include a one-page methodology summary at the front of your risk register. State the scope, the scale definitions, the aggregation formula, and the acceptance threshold. An auditor who can read that summary in two minutes will spend less time questioning your scoring decisions.

How to define likelihood, impact, and risk acceptance criteria

Consistent scoring depends on scales that are defined precisely enough that different assessors reach the same conclusion for the same scenario. The following sample scales are illustrative; your organization must adapt them to its context and document the definitions formally.

Sample likelihood scale defined by organization-specific criteria

ScoreLabelDefinition
1RareExpected to occur less than once every five years
2UnlikelyCould occur once every two to five years
3PossibleCould occur once per year
4LikelyCould occur multiple times per year
5Almost CertainExpected to occur frequently or is actively observed

Sample impact scale defined by organization-specific criteria

Risk matrix and acceptance criteria

Combine likelihood and impact scores to produce the inherent or residual risk rating.

Rating RangeRisk LevelDefault Treatment Requirement
1–4LowAccept; document rationale
5–9MediumAccept with monitoring; or mitigate
10HighTreatment required; owner approval mandatory
—ExtremeImmediate treatment required; executive escalation

The acceptance threshold is the boundary above which treatment is mandatory. A common starting point is to set the threshold at 9, meaning any residual risk rated 10 or above requires a documented treatment plan. The threshold must be approved by management and recorded in the methodology document.

The process for applying these scales follows a clear sequence:

  1. Score inherent likelihood and impact before considering existing controls.
  2. Document existing controls and re-score residual likelihood and impact.
  3. Calculate residual risk rating and compare to the acceptance threshold.
  4. If residual risk exceeds the threshold, select a treatment option and identify Annex A controls.
  5. Project the post-treatment residual risk rating to confirm the treatment is expected to bring the risk within acceptable bounds.
  6. Record the target residual rating in the register as the expected outcome of the treatment plan.

Selecting controls, documenting treatment decisions, and producing the SoA

The four treatment options each carry specific auditor expectations. Selecting the right option for each risk and documenting the rationale is what converts a risk register into an auditable artefact.

  • Modify (mitigate). Apply one or more controls to reduce likelihood, impact, or both. This is the most common treatment for High and Extreme risks. The register must identify the specific Annex A controls selected and the expected residual rating after implementation.
  • Retain (accept). Accept the risk as-is, typically for Low or Medium risks where the cost of mitigation exceeds the expected loss. The register must include a named owner who has formally accepted the risk and the rationale for acceptance. Auditors will scrutinize accepted risks above the stated threshold.
  • Avoid. Eliminate the activity or asset that creates the risk. This option is appropriate when the risk cannot be reduced to an acceptable level and the activity is not business-critical. The register must document what was discontinued and when.
  • Share (transfer). Transfer the financial consequence of the risk to a third party, typically through cyber insurance or a contractual indemnity. Sharing does not eliminate the risk; the organization retains responsibility for the underlying vulnerability. The register must note the transfer mechanism and confirm that residual risk after transfer is within the acceptance threshold.

SoA mapping requirement: for every risk where a treatment decision selects Annex A controls, those control IDs must appear in both the risk register and the SoA. The SoA must also include every Annex A control not selected, with a documented justification for exclusion. An SoA that lists only selected controls is incomplete and will generate an audit finding.

A compact mapping example illustrates the required traceability:

A risk control matrix is a useful companion document to the SoA, providing a structured view of which controls address which risks and where coverage gaps exist.

Roles, responsibilities, and governance required to run and defend your risk assessment

A risk assessment without clearly assigned roles produces orphaned risks, unsigned treatment decisions, and audit findings. The following roles are the minimum governance structure for a defensible ISMS.

ISMS Manager. Owns the methodology, maintains the risk register, schedules reviews, and coordinates the assessment process. This role is accountable for the completeness and consistency of the register and is the primary point of contact for auditors during the risk assessment review.

Risk Owner. Named for each individual risk. The risk owner approves the treatment decision for their assigned risks, confirms the residual rating is acceptable, and is responsible for implementing or overseeing the treatment plan. Risk owners are typically business process owners or system owners, not the ISMS Manager.

Asset Owner. Responsible for the information asset at risk. The asset owner provides context on asset criticality, existing controls, and business impact, and may be the same person as the risk owner for asset-specific risks.

Executive Approver. Management-level sign-off on the overall risk assessment results, the acceptance threshold, and the SoA. ISO 27001 requires demonstrable management involvement; an unsigned or undated management approval is a common audit finding.

Business Process Owner. Provides operational context for risks affecting specific business processes and validates that proposed controls are operationally feasible.

Regarding review cadence, the standard requires assessment at planned intervals and on significant changes. In practice, most organizations operate a three-tier cadence: a full annual review that reassesses all risks, scores, and treatment decisions; quarterly updates that address new risks, closed treatments, and changes to existing entries; and event-triggered reassessments following incidents, major system changes, new regulatory requirements, or significant organizational changes such as mergers or new product launches, among other things.

Pro Tip: Maintain a change log within the risk register that records who made each update, when, and why. This single addition transforms a static spreadsheet into an auditable record of continual improvement, which is exactly what Clause 10.2 requires.

Approval and escalation paths must be documented. Any risk rated High or Extreme that is proposed for acceptance rather than treatment should require escalation to the executive approver, with a documented rationale. Auditors will specifically look for evidence that management was aware of and formally accepted high-rated risks.

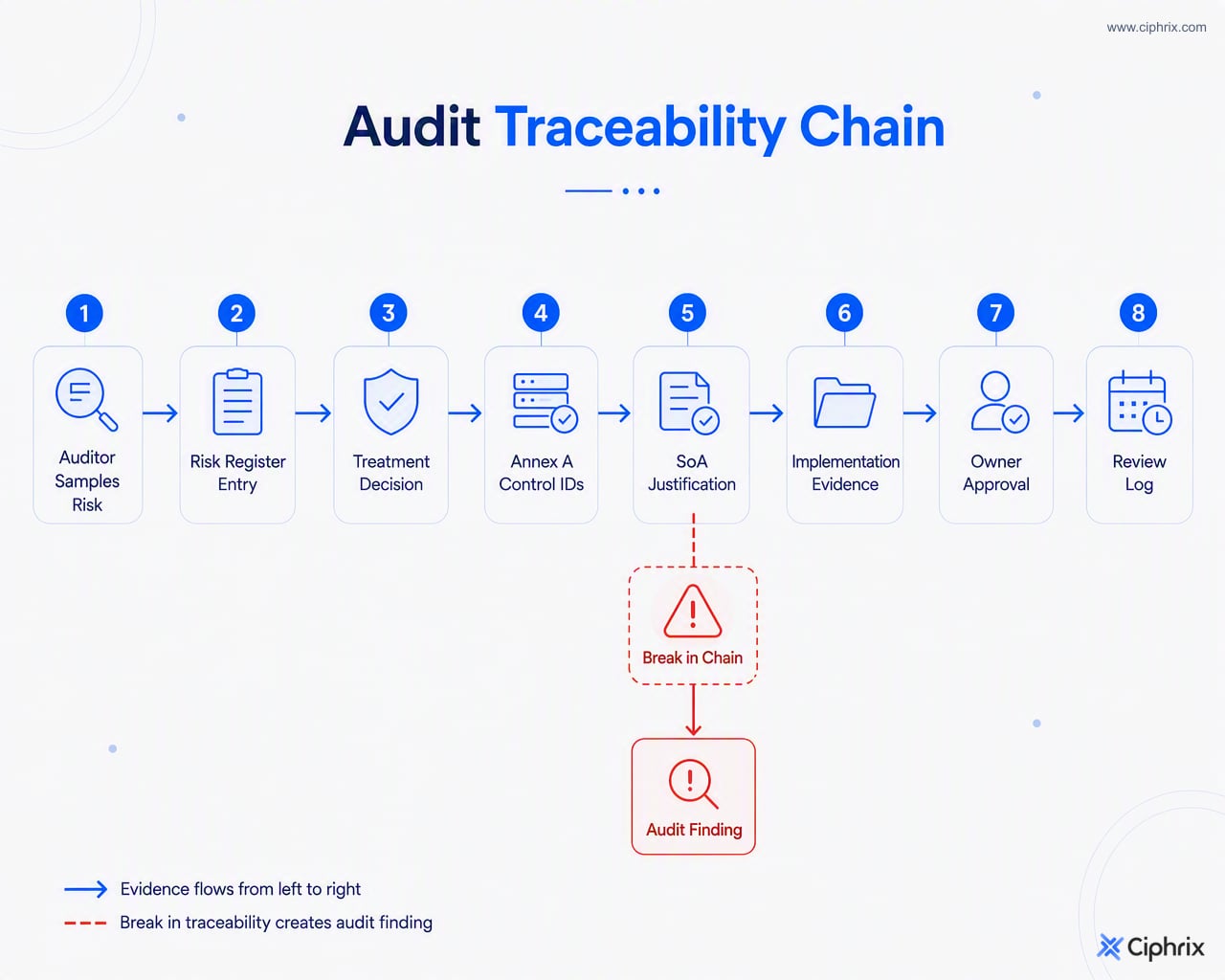

What auditors look for: the risk register, treatment plan, SoA, and supporting evidence

Audit sampling during an ISO 27001 certification or surveillance audit usually follows a fairly predictable pattern. If the organization understands that pattern, it can prepare artefacts that answer the auditor's questions before they are asked.

Auditors will typically request and review the following:

  • The documented risk assessment methodology (scope, scales, aggregation formula, acceptance threshold, and review cadence)
  • The current risk register, including inherent and residual ratings, named owners, treatment decisions, and review dates
  • Evidence of management approval of the risk assessment results and the acceptance threshold
  • The completed SoA, with justifications for both included and excluded Annex A controls
  • Treatment plan records showing the status of open treatment actions, responsible parties, and target completion dates
  • Review logs demonstrating that the assessment was repeated at the planned interval and after significant changes
  • Evidence that risk owners were involved in and approved their assigned treatment decisions

Common audit sampling pattern: auditors often select three to five risks from different rating levels (at least one High or Extreme, one Medium, and one accepted risk) and trace each from the register entry through the treatment decision to the SoA control mapping and the implementation evidence. If that traceability chain breaks at any point, a nonconformity is raised.

When presenting the register during an audit, organize it so the auditor can filter by risk rating, treatment status, and review date without help. A register that needs explanation to navigate signals poor documentation discipline. Cross-reference columns between the register and the SoA should use consistent identifiers so the auditor can verify the mapping on their own.

For audit readiness, maintain a concise management summary that shows the distribution of risks by rating level, the number of open treatment actions, and the date of the last formal review. This summary serves as the entry point for the audit conversation and shows that management has visibility into the risk posture.

Trade-offs: spreadsheets vs. purpose-built tools vs. AI-assisted automation

The tooling choice for an ISO 27001 risk assessment affects not just efficiency but the defensibility of the artefacts produced. Each approach has a legitimate place depending on organizational size, complexity, and maturity.

Spreadsheets

Spreadsheets remain acceptable for initial assessments in smaller organizations with a limited asset inventory and a single ISMS scope. They are flexible, require no procurement, and can be structured to meet the minimum field requirements. The limitations become messy at scale: version control is manual, audit trails are absent unless the organization uses a version-controlled repository, concurrent editing creates conflicts, and cross-referencing between the register and the SoA requires manual maintenance. For organizations with more than 50 risks or multiple reviewers, spreadsheet-based registers tend to develop inconsistencies that surface during audit sampling.

Purpose-built GRC and risk-management software

Dedicated governance, risk, and compliance platforms address the structural limitations of spreadsheets by providing centralized registers with enforced field schemas, automated audit trails, workflow-driven approvals, and built-in cross-references between risks, controls, and the SoA. When evaluating purpose-built tools, the practical selection criteria are: whether the tool enforces the minimum field set, whether it produces an exportable SoA in a format auditors can review, whether it maintains a change log with timestamps and user attribution, and whether it supports the review cadence with automated reminders.

AI-assisted automation

AI-driven platforms can accelerate the most time-consuming phases of the assessment: asset discovery, threat and vulnerability identification, control suggestions mapped to Annex A, and evidence aggregation. The governance safeguard that must accompany any AI-assisted process is human owner approval for every suggested risk entry, score, or control mapping. An AI-generated register entry that has not been reviewed and approved by a named owner is not defensible under Clause 6.1.2, regardless of how accurate the suggestion may be.

Governance principle for AI-assisted assessments: treat every AI-generated suggestion as a draft requiring human review, not a completed record. The audit trail must show that a named owner reviewed, modified if necessary, and approved each entry. Automation accelerates the process; human judgment and documented approval make it auditable.

Pro Tip: When selecting any tool, verify that it exports the risk register and SoA in a format your external auditor can open and navigate without requiring access to the platform itself. Auditors should not need a platform login to review your artefacts.

How AI-driven automation speeds ISO 27001 risk assessments

Organizations that have moved from spreadsheet-based processes to AI-assisted platforms report material reductions in the time required to complete an initial assessment and maintain the register through surveillance cycles. The tasks where automation delivers the most consistent time savings are:

  • Asset discovery and inventory population. AI agents can scan connected systems, cloud environments, and configuration management databases to generate an initial asset list, reducing the manual inventory effort from days to hours.
  • Threat and vulnerability mapping. Automated suggestion of threat-vulnerability pairs for each asset type, drawn from current threat intelligence, gives assessors a structured starting point rather than a blank register.
  • Annex A control suggestions. For each identified risk, the platform suggests applicable Annex A controls based on the risk type and treatment decision, reducing the manual mapping effort and the likelihood of missed controls.
  • Evidence aggregation. Continuous monitoring integrations pull evidence of control operation (access logs, patch records, training completion rates) directly into the platform, reducing the manual evidence collection burden before audits.
  • Owner approval workflows. Automated notifications route treatment decisions to named risk owners for review and approval, creating a timestamped audit trail without manual follow-up.

Ciphrix's AI compliance agents automate these tasks within a single platform, producing a register that is populated, mapped to Annex A, and linked to an evidence library from the outset. The Ciphrix ISO 27001 compliance platform supports the full assessment lifecycle, from initial scoping through SoA production and ongoing review management.

Pro Tip: Require that every AI-suggested entry in the register carry a "reviewed by" field that is populated only after a named human owner has confirmed the entry. Configure the platform to prevent the entry from moving to "approved" status without that field being completed. This single workflow control is what makes an AI-assisted register auditable.

Common pitfalls and audit red flags — and how to fix them quickly

The most frequent causes of nonconformity findings in ISO 27001 risk assessment audits are not complex methodology failures. They are documentation gaps — or, more precisely, evidence gaps — that a practitioner can identify and correct before the auditor samples the artefacts.

No documented methodology. The register exists but there is no written description of the scales, aggregation formula, or acceptance threshold. Fix: draft a one-to-two page methodology document, have management approve it, and attach it to the register as a cover sheet or linked document.

No named risk owners. The "Risk Owner" column is blank or contains a team name rather than an individual. Fix: assign a named individual to each risk and obtain their written acknowledgment of the treatment decision. A team name is not an owner for audit purposes.

Missing or expired review dates. Risks have no review date, or the review date has passed with no evidence of a review having occurred. Fix: add a review date to every entry and create a calendar event or platform reminder for each scheduled review. Retain the review notes as documented evidence.

Controls in the SoA without risk justification. The SoA lists controls that cannot be traced to any risk in the register. Fix: for each orphaned SoA control, either identify the risk that justifies it and add the cross-reference, or document the alternative justification (legal requirement, contractual obligation, or management decision) in the SoA justification column.

SoA mismatches with the 2022 Annex A structure. The SoA uses the 2013 control numbering. Fix: remap the SoA to the 2022 Annex A control IDs (93 controls across four themes) and document the mapping from the old structure to the new one as a transition record.

Accepted risks above the stated threshold. The register shows risks rated above the acceptance threshold with a treatment decision of "Accept" and no escalation record. Fix: either obtain documented executive approval for each accepted high-rated risk, or initiate a treatment plan and update the status.

To demonstrate corrective action and continual improvement to an auditor, maintain a log of findings from previous reviews, the corrective actions taken, and the dates on which those actions were verified as complete. This log is the evidence — really, the audit trail — that Clause 10.1 (nonconformity and corrective action) and Clause 10.2 (continual improvement) are being met.

Pro Tip: Run a pre-audit self-check using the auditor's own sampling pattern: select three risks at random (one High, one Medium, one accepted), and trace each from the register entry through the treatment decision to the SoA control mapping and the implementation evidence. If you cannot complete that trace in under five minutes per risk, the register needs work before the audit.

Practical checklist and estimated timeline for an initial assessment and ongoing maintenance

Planning the assessment as a project with defined milestones prevents the common failure mode of an incomplete register that stalls certification. The following timeline assumes a mid-sized organization with a defined ISMS scope and a dedicated ISMS Manager supported by part-time business unit contributors.

Phase 1: Initial baseline assessment (Weeks 1–8)

  1. Weeks 1–2: Scope and criteria definition. Define the ISMS scope, draft the methodology document (scales, aggregation formula, acceptance threshold), identify asset categories, and assign the ISMS Manager and executive approver. Deliverable: approved methodology document.
  2. Weeks 3–4: Asset inventory and threat mapping. Conduct asset discovery workshops with business process owners, populate the asset inventory, and identify threat-vulnerability pairs for each asset category. Deliverable: draft asset inventory with threat-vulnerability pairs.
  3. Weeks 5–6: Scoring and evaluation. Score inherent and residual likelihood and impact for each risk, calculate risk ratings, and evaluate against the acceptance threshold. Deliverable: draft risk register with inherent and residual ratings.
  4. Week 7: Treatment decisions and SoA mapping. Assign treatment options, select Annex A controls, and populate the SoA with justifications for included and excluded controls. Obtain risk owner approvals. Deliverable: approved treatment plan and draft SoA.
  5. Week 8: Management review and sign-off. Present the risk register and SoA to the executive approver for formal approval. Record the approval date and approver name. Deliverable: signed risk register and completed SoA.

Phase 2: Steady-state maintenance

  1. Quarterly updates. Review new risks identified since the last update, update treatment statuses, and record any changes to existing entries. Estimated effort: 4–8 hours per quarter for the ISMS Manager, plus owner confirmations.
  2. Annual full review. Reassess all risks, update scores to reflect changes in the threat environment and control effectiveness, and obtain fresh management approval. Estimated effort: 2–4 days for the ISMS Manager, plus 1–2 hours per business unit contributor.
  3. Event-triggered reassessment. Conduct an ad-hoc review within 30 days of a significant change (new system deployment, incident, regulatory change, or organizational restructuring). Document the trigger, the risks reviewed, and any changes to the register.

The executive approver requires approximately 2–4 hours for the final review and sign-off.

What practitioners consistently get wrong about ISO 27001 risk assessments

The prevailing assumption among teams approaching their first ISO 27001 certification is that the risk assessment is primarily an analytical exercise. Get the scores right, select the right controls, and the audit will follow. That framing misses the actual source of most nonconformity findings.

Auditors are not primarily evaluating whether your risk scores are correct. They are evaluating whether your process is documented, repeatable, and governed. A register with imperfect scores but a clear methodology, named owners, dated approvals, and traceable SoA mappings will pass an audit. A register with technically accurate scores but no methodology document, anonymous entries, and an SoA that cannot be traced to specific risks will not.

The second misunderstanding is treating the risk assessment as a certification deliverable rather than an operational process. Organizations that complete the register, achieve certification, and then leave the register unchanged until the next surveillance audit are accumulating nonconformities. The standard's requirement for reassessment at planned intervals and after significant changes is not a formality. A register that has not been updated since the last audit, despite the organization having deployed new cloud infrastructure, onboarded a major vendor, or experienced a security incident, is direct evidence of a failed process.

The practical implication is that the governance structure matters as much as the methodology. Assign real owners, schedule real reviews, and build a real review cadence into the organization's operational calendar rather than treating it as a compliance task that surfaces only when an audit approaches. That shift in posture is what separates organizations that maintain certification with minimal audit findings from those that spend the weeks before each surveillance audit in remediation mode.

Ciphrix cuts the time from risk assessment to audit-ready evidence

Completing an ISO 27001 risk assessment manually, from asset inventory through SoA production and evidence collection, typically consumes weeks of ISMS Manager time and requires sustained coordination across business units. Ciphrix's AI-powered risk management platform automates the most labor-intensive steps: asset discovery, threat-vulnerability mapping, Annex A control suggestions, and evidence aggregation. The result is a populated, cross-referenced register that is ready for owner review from day one, not week six.

Automation suggests; human owners approve. Every AI-generated entry in the Ciphrix platform requires named owner sign-off before it reaches approved status, preserving the audit trail that Clause 6.1.2 demands. Treatment decisions, SoA mappings, and review completions are all timestamped and attributed, producing the documented evidence auditors sample.
