Building a vendor risk steering committee that scales

Anish / CTO/Co-Founder
Building a vendor risk steering committee that scales

Vendor risk decisions usually stall when the organization has assessments, contracts, and business owners, but no clear place to decide what happens when risk is unresolved. A vendor risk steering committee fixes that by defining who can approve, who must be consulted, when risk is escalated, and what evidence is retained.

Use the committee for material vendor-risk decisions. Not every supplier interaction. NIST’s cybersecurity supply-chain guidance supports coordinated governance across the functions involved in supplier risk management, with clear roles and responsibilities, while leaving the operating model to each organization’s context (NIST C-SCRM Quick-Start Guide).

What a vendor risk steering committee is responsible for

A vendor risk steering committee is a cross-functional governance body, it handles decisions that cannot be resolved cleanly by one team.

It does not replace:

  • procurement’s sourcing and vendor lifecycle process
  • security or GRC due diligence
  • legal contract review
  • privacy review
  • the business owner’s accountability for using the vendor
  • operational vendor management

Its job is to define thresholds, resolve ambiguity, approve or escalate material risk decisions, and maintain a defensible record of what was decided.

In practice, the committee should focus on:

  • critical or high-risk vendors
  • unresolved due-diligence findings
  • risk-related contract exceptions
  • compensating controls
  • overdue remediation
  • vendor incidents or monitoring triggers
  • renewals where risk has changed
  • offboarding risks for critical services, access, or data

Routine low-risk supplier approvals should stay with the normal procurement, security, legal, or business-owner workflow.

When to create a vendor risk steering committee

Consider a formal committee when material vendor-risk decisions repeatedly require cross-functional resolution or escalation.

Common indicators include:

  • critical vendors are being approved without a consistent risk decision record
  • security, procurement, legal, and business teams disagree on whether a vendor can proceed
  • unresolved findings are accepted informally by email or chat
  • risk exceptions are not time-bound or reviewed
  • no one can show who approved a risky vendor, on what basis, and with what conditions
  • high-risk vendors are increasing faster than the existing review process can handle
  • audit, executive, or customer-facing evidence requests are difficult to answer because records are fragmented

A smaller organization may not need a standing committee immediately. That may sound like avoiding governance. It is really just matching the process to the amount of risk in front of the team. It can start with a lightweight review meeting for critical vendors and open exceptions, then formalize the charter once decision volume, risk exposure, or accountability gaps justify it.

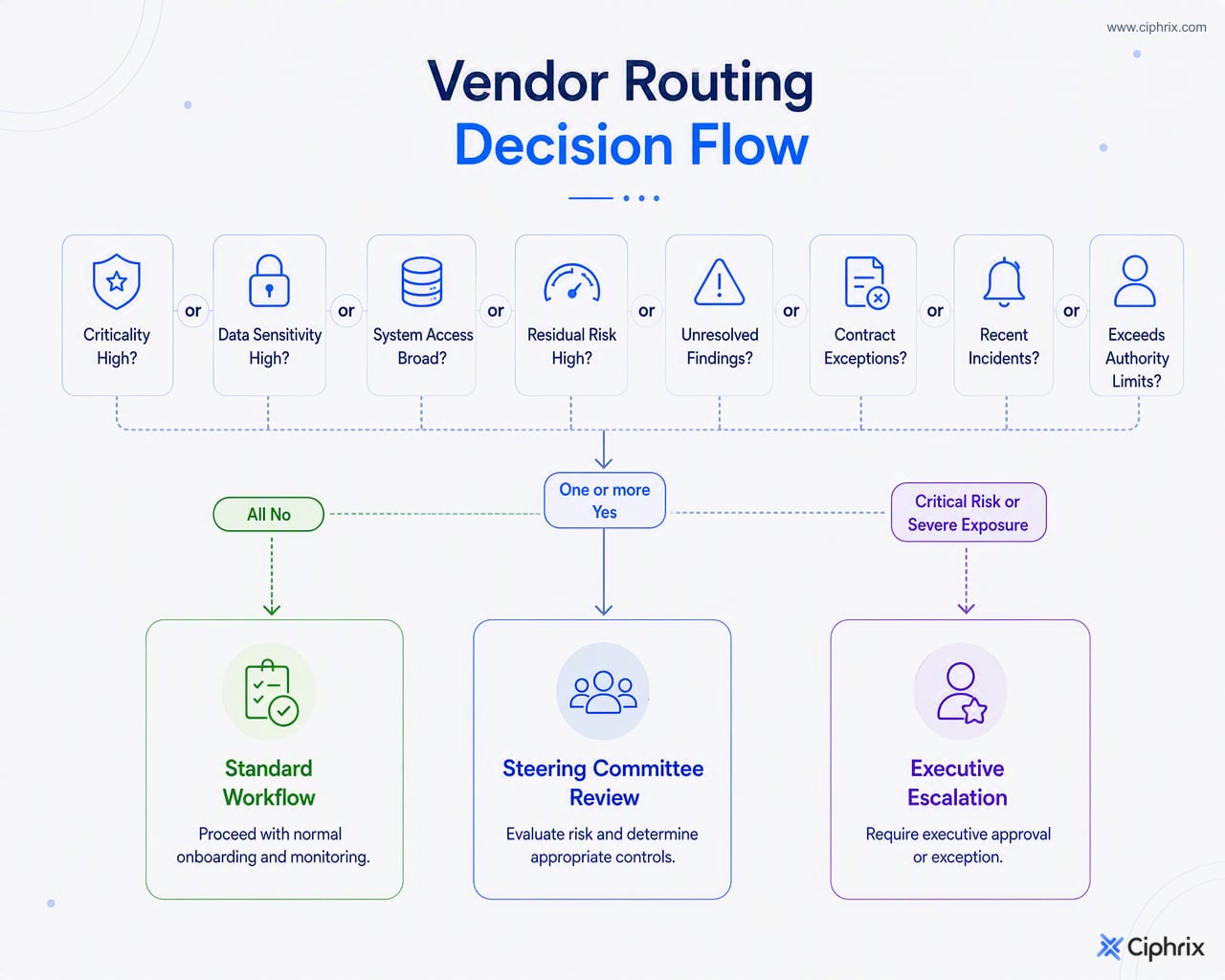

The scaling rule is simple: route vendors to the committee based on criticality, data sensitivity, system access, and residual risk, not because every supplier needs the same governance path. NIST’s C-SCRM guidance supports prioritizing suppliers using criteria such as business importance, data sensitivity, and system access, and applying requirements proportionately to criticality and potential impact (NIST C-SCRM Quick-Start Guide).

Who should sit on the committee and who should chair it

Select members based on the decisions the committee is expected to make. Attendance and approval authority are not the same thing: some participants provide input, while only named decision owners approve or escalate.

FunctionTypical contributionUsually accountable for
Security / information securityControl findings, threat exposure, technical risk, compensating controlsSecurity risk recommendation
GRC / risk / complianceRisk methodology, evidence expectations, policy alignment, exception trackingRisk record and governance process
Procurement / vendor managementIntake, sourcing status, vendor relationship, renewal timing, commercial leverageVendor lifecycle coordination
LegalContract terms, liability, indemnity, security clauses, termination rightsLegal position on contractual exceptions
PrivacyPersonal data, processing risks, data protection terms where relevantPrivacy risk input
Finance / operationsBusiness continuity, cost, operational dependency where relevantOperational or financial impact input
Business ownerBusiness need, operational impact, alternatives, acceptance of service riskBusiness ownership of vendor use
Executive sponsorRisk appetite conflict, escalation, authority beyond committee delegationFinal escalation path where needed

Chairing model depends on how vendor risk operates inside the company:

  • A security or GRC chair can work where the committee is primarily risk-led.
  • A procurement or vendor management chair can work where procurement owns the vendor lifecycle and risk is embedded into that process.
  • A co-chair or rotating chair can work in larger organizations, but only if the charter names one accountable owner for agenda control, records, and follow-up.

The chair does not need to be the highest-ranking person in the room. They just need enough authority to keep the process from drifting: what is in scope, what decision is required, who owns the risk, what evidence is sufficient, and when escalation is triggered.

Write the committee charter before the first decision

The charter is the committee’s operating contract. It prevents the group from becoming a discussion forum with unclear authority.

Use the template below as a starting point and tailor it to your delegated-authority model, risk appetite, legal obligations, and organizational structure.

Vendor risk steering committee charter template

Charter fieldStarting language to adapt
PurposeGovern material vendor-risk decisions by defining review thresholds, approval authority, escalation paths, and required records.
ScopeApplies to vendors that meet defined criticality, risk, data, access, regulatory, contractual, or business-continuity thresholds. Excludes routine low-risk supplier approvals handled through standard workflows.
Vendor tiers in scopeCommittee review applies to critical and high-risk vendors, and to lower-tier vendors only when an exception, incident, unresolved finding, or escalation trigger exists.
Standing membersName voting or approval members separately from advisors. Include the functions needed for the committee’s decision scope.
Optional attendeesInvite business owners, system owners, regional leads, privacy specialists, incident responders, or vendor managers when their subject matter is on the agenda.
ChairNames the accountable chair responsible for agenda control, meeting discipline, decision confirmation, and follow-up.
Secretary / record ownerNames the person or function responsible for agendas, minutes, decision logs, risk acceptance records, and action tracking.
QuorumDefines the minimum attendance needed for decisions, such as chair plus required risk, procurement, legal/privacy, and business-owner representation for the agenda items under review.
AuthorityStates what the committee can approve, recommend, defer, or escalate. Align this with internal delegation of authority.
Decision modelDefines whether decisions are made by consensus, named approver, majority vote, or executive sponsor decision after recommendation.
Decision rightsSpecifies approvals by category: onboarding, exception, compensating control, remediation extension, renewal, incident response action, or offboarding risk.
Risk acceptance authorityIdentifies who may accept residual vendor risk, for what tier or severity, and when acceptance must be escalated.
Escalation triggersDefines triggers such as unacceptable residual risk, unresolved legal position, lack of business owner, expired exception, repeated control failure, incident impact, or decision outside committee authority.
Urgent decisionsDefines how urgent decisions are handled between meetings, who can make interim decisions, and how ratification is recorded at the next meeting.
CadenceSets a cadence based on volume and urgency of material decisions, with ad hoc sessions for incidents or urgent exceptions.
Required recordsAgendas, attendance, quorum confirmation, evidence reviewed, decisions, rationale, risk owner, conditions, expiry or review date, actions, and escalation records.
ReportingDefines management reporting and executive or board visibility where applicable.
Review cycleReviews the charter periodically or after major changes in vendor risk profile, organizational structure, delegated authority, or risk appetite.

A good charter answers four questions before any vendor is discussed:

  1. Is this decision in scope for the committee?
  2. Who has authority to approve, reject, defer, or escalate?
  3. What evidence must be reviewed?
  4. What record must exist after the decision?

Define what the committee approves, escalates, and records

The committee’s value comes from decision clarity. If every case results in “follow up offline,” the case is just being parked and the operating model has failed.

For material risk decisions, identify the accountable decision authority, consider residual risk and organizational risk tolerance, communicate the decision and any conditions, and use current assessment information. That principle is consistent with NIST’s risk management guidance, though organizations should not import federal authorization roles into vendor governance unless they apply to their environment (NIST SP 800-37 Rev. 2).

Committee operating pack: decision and escalation matrix

Use this as an editorial starting point, not a universal delegation model.

Decision categoryCommittee may approve when…Escalate when…Record required
Critical or high-risk vendor onboardingDue diligence is complete enough for a risk decision and residual risk is within delegated authorityResidual risk exceeds authority, legal position is unresolved, or business owner will not accept conditionsApproval decision, evidence reviewed, conditions, owner, review date
Vendor with unresolved security findingsFindings have compensating controls, remediation owner, and target dateFindings affect critical data, core service availability, or risk appetite conflictRisk acceptance or conditional approval record
Contract security exceptionException is understood and alternative controls or business rationale are documentedMissing clause creates exposure outside delegated authority or conflicts with required contractual commitmentsContract exception record and legal input
Remediation deadline extensionVendor provides credible revised date and interim controlRepeated missed deadlines, no owner, or material exposure remains unmanagedExtension decision, new due date, interim control
Compensating control approvalControl reduces residual risk to an acceptable level for the decision authorityControl is untested, unowned, or insufficient for the riskControl rationale and review condition
Vendor incident or trigger eventResponse actions are within committee authority and business impact is understoodIncident may materially affect customers, regulated data, critical operations, or executive risk appetiteIncident decision record, actions, communications owner
Renewal of critical vendorRisk posture remains acceptable or conditions are updatedRisk has deteriorated, unresolved findings persist, or alternatives are being consideredRenewal risk decision and conditions
Offboarding or transition riskAccess removal, data handling, and service transition are assignedData return/deletion, access revocation, or continuity risk is unresolvedOffboarding risk record and action owners

Committee operating pack: practical RACI

NIST’s C-SCRM guide supports documenting accountable roles and using a responsibility matrix to show who is responsible, accountable, consulted, and informed (NIST C-SCRM Quick-Start Guide).

ActivityBusiness ownerSecurity / GRCProcurementLegal / privacyCommitteeExecutive sponsor
Vendor intakeRCA/RC where relevantII
Tiering criteriaCA/RRCA for thresholdsI
Due-diligence findingsCA/RCCA for material exceptionsI
Contract exceptionsCCRA/RA for material risk exceptionsI or A if escalated
Risk acceptanceA for business useR for risk analysisCCA within delegationA when escalated
Remediation trackingR for vendor relationship impactR for risk issueA/R for vendor follow-upCI or A for extensionsI
Incident escalationR for business impactA/R for risk analysisCCA within delegationA when escalated
Renewal risk reviewA/RRA/RCA for critical/high-risk casesI or A if escalated
Offboarding safeguardsRCA/RCI or A for critical riskI

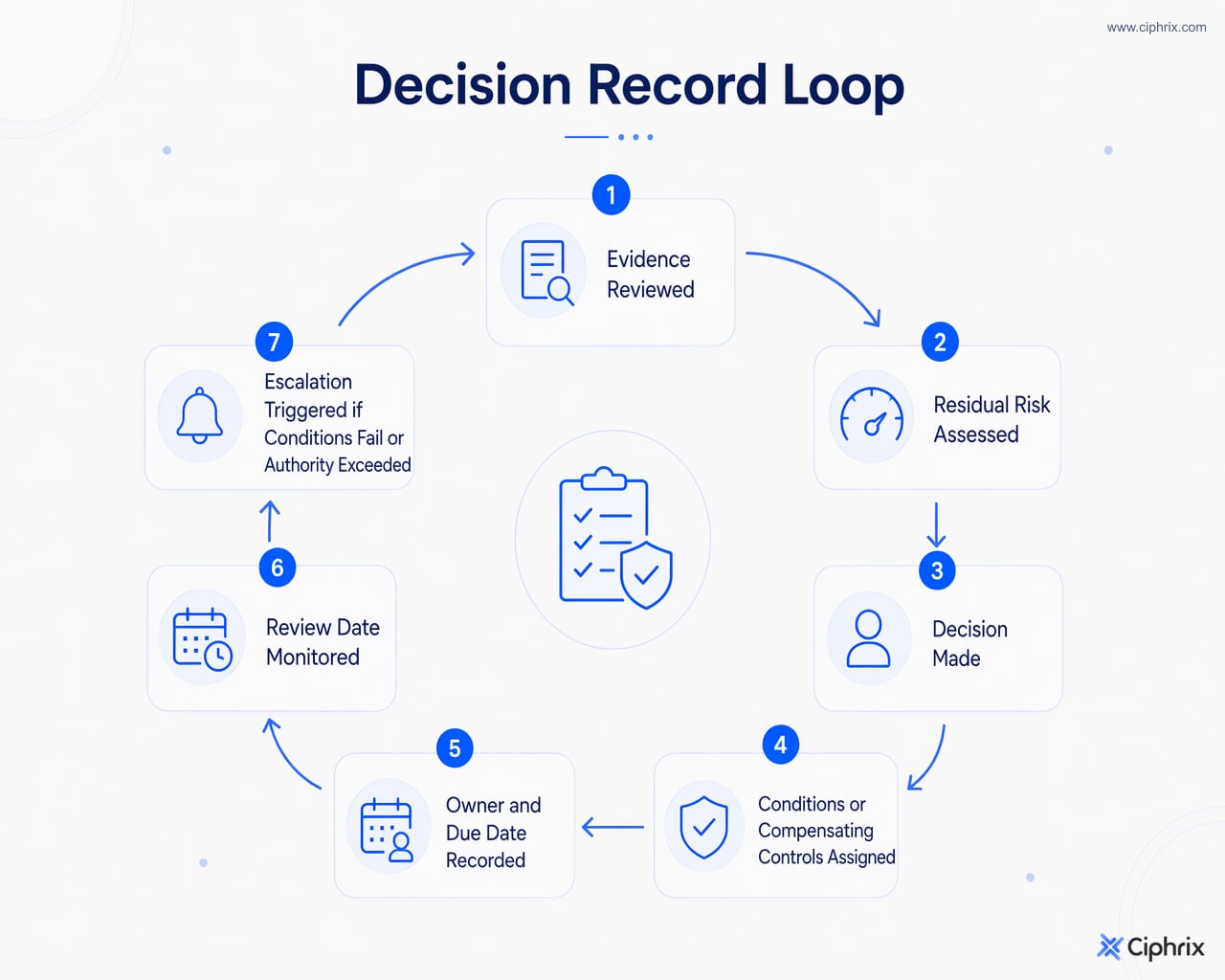

Committee operating pack: risk acceptance log fields

A practical internal risk acceptance record can capture:

FieldWhy it matters
Vendor name and tierShows criticality and routing basis
Decision dateEstablishes when the risk was reviewed
Decision ownerIdentifies accountable approval authority
Risk ownerIdentifies who owns the business impact of accepting the risk
Summary of issueStates the unresolved risk in plain language
Evidence reviewedShows what information supported the decision
Residual riskClarifies what remains after controls or remediation
RationaleExplains why approval, deferral, rejection, or escalation was chosen
Conditions or compensating controlsStates what must be true for the decision to remain valid
Expiry or review datePrevents indefinite exceptions
Follow-up actions and ownersConverts the decision into tracked work
Escalation pathShows where the decision goes if conditions fail

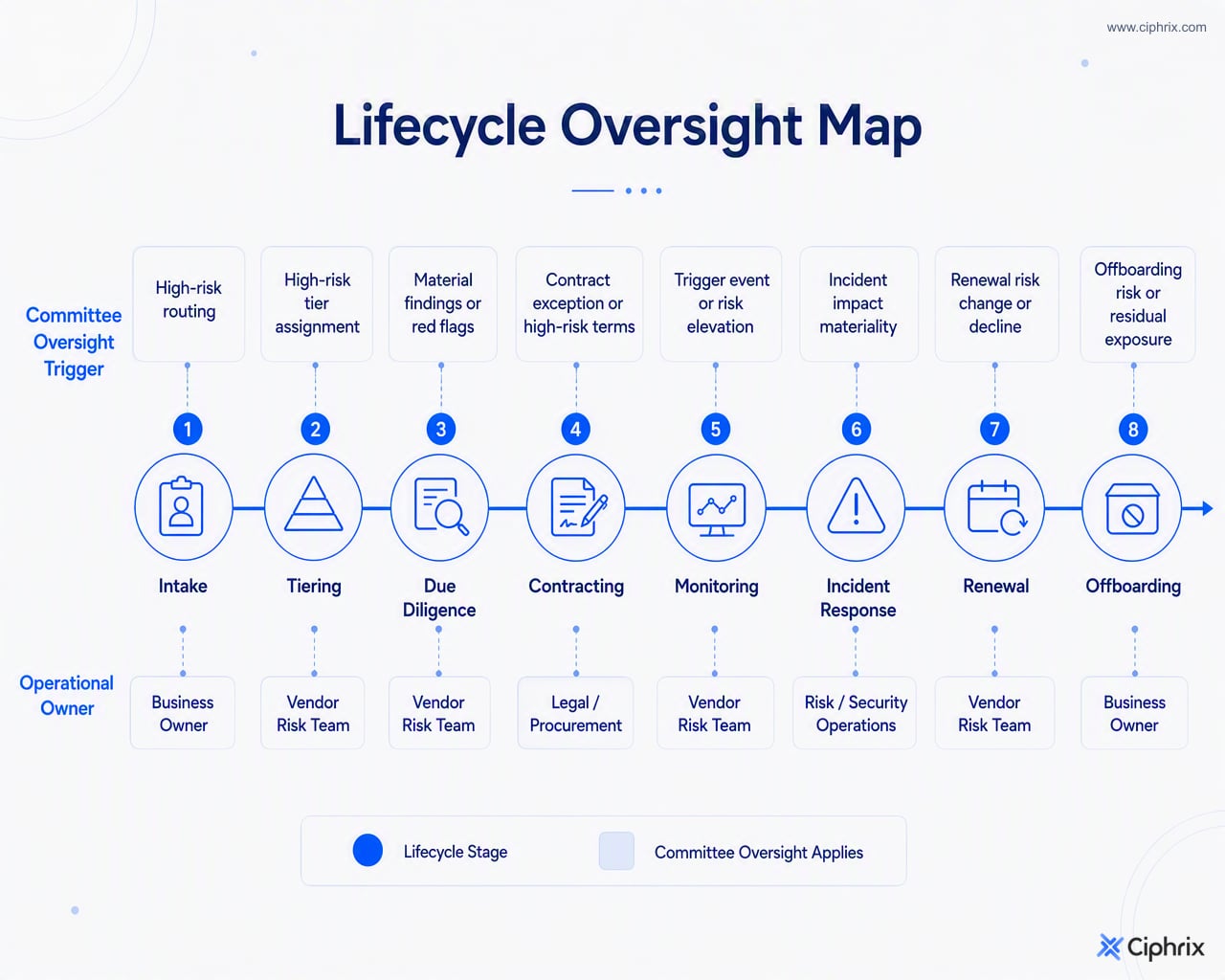

Map committee oversight across the vendor lifecycle

The committee governs thresholds, exceptions, and escalations across the lifecycle. Operational teams still perform the work, which is the main thing.

Lifecycle stageOperational ownerCommittee oversight
Intake / onboardingProcurement, business ownerReviews only vendors meeting risk, criticality, data, access, or exception thresholds
TieringSecurity/GRC, procurement, business ownerConfirms criteria for critical and high-risk routing
Due diligenceSecurity/GRC, privacy, legal where relevantReviews material findings, unresolved issues, and proposed compensating controls
ContractingProcurement and legalReviews risk-related exceptions or missing security provisions where material
Ongoing monitoringSecurity/GRC, vendor management, business ownerReviews deteriorating posture, missed remediation, trigger events, or incidents
Incident responseSecurity, incident response, legal/privacy, business ownerConfirms risk decisions and escalation where vendor impact is material
RenewalProcurement, business owner, Security/GRCConfirms whether risk conditions have changed before renewal
OffboardingProcurement, business owner, IT/security, legal where relevantEnsures critical access, data return/deletion, transition, and residual risk are assigned

NIST’s C-SCRM guide supports tailoring supplier requirements to criticality, including requirements in agreements, monitoring throughout the supplier relationship lifecycle, and considering relevant suppliers in incident planning, response, and recovery (NIST C-SCRM Quick-Start Guide). The UK NCSC also advises keeping a prioritized supplier list, seeking security evidence proportionate to risk, including incident-reporting expectations in contracts, and addressing return or deletion of information and assets at termination or transfer (NCSC Supply chain security).

Run the first meeting and the recurring meeting rhythm

The first meeting should establish the operating model before reviewing a long list of vendors. Otherwise, the committee will make precedent-setting decisions without agreed authority.

Committee operating pack: first-meeting agenda

Agenda itemOutput
Confirm purpose and scopeAgreed committee remit
Confirm members, chair, quorum, and record ownerNamed roles and attendance rules
Approve draft charter or assign final editsCharter approval path
Agree vendor tiers and routing thresholdsClear criteria for committee review
Review current critical/high-risk vendor listInitial governed population
Identify open exceptions and unresolved risksStarting decision backlog
Confirm decision and escalation matrixDelegated authority boundaries
Approve dashboard fieldsReporting baseline
Assign actions, owners, and datesLaunch action register

Committee operating pack: recurring agenda

Agenda itemDecision or record produced
Prior actionsClosed, extended, or escalated actions
New critical/high-risk vendor requestsApproval, rejection, deferral, or escalation
Exception and risk acceptance requestsDecision record and conditions
Overdue remediationExtension, escalation, or vendor action
Incidents or monitoring triggersResponse decision and owner
Upcoming critical-vendor renewalsRenewal risk decision or required follow-up
Dashboard reviewTrends requiring action
EscalationsExecutive or other governance referral
Minutes and action confirmationFinal record of decisions and owners

Set cadence to match the volume and urgency of material decisions. Monthly may be appropriate for active or maturing programs with regular exceptions. Quarterly may be enough for stable programs with fewer high-risk vendors. Use ad hoc meetings for incidents, urgent exceptions, or critical vendor changes that cannot wait, at least as a starting point.

Build a committee dashboard and evidence trail

The dashboard should show what needs a decision, not everything known about every vendor.

Committee operating pack: dashboard fields

Dashboard fieldDecision it supports
Number of critical and high-risk vendorsCommittee workload and exposure
Vendors awaiting assessment or renewal reviewBottlenecks before approval or renewal
Open high-severity findingsRisk decisions and remediation priority
Overdue vendor remediationsEscalation or deadline extension
Active risk acceptances and review datesExpiring or stale exceptions
Contract or security exceptionsLegal and risk follow-up
Vendor incidents or trigger eventsIncident escalation and monitoring response
Vendors missing expected evidenceConditional approval or follow-up
Escalations awaiting executive decisionDecisions outside committee authority
Actions overdue by ownerAccountability and meeting follow-through

Retain enough records to show what was decided, by whom, on what evidence, and what follow-up was assigned. A practical evidence trail includes:

  • agendas
  • attendance and quorum confirmation
  • minutes
  • decision logs
  • risk acceptance records
  • evidence reviewed
  • action owners and due dates
  • escalation records
  • periodic management summaries
  • executive or board materials where applicable

This record supports continuity when committee members change and gives management a clearer view of unresolved vendor risk.

From Ciphrix’s perspective, committee reporting works best when evidence, controls, risks, exceptions, and action ownership are kept current as part of the operating system of compliance, not recreated before each meeting. That does not replace committee judgment, but it can make decisions easier to trace back to current records.

How to scale the committee without slowing vendor decisions

A scalable committee is selective. It gives low-risk vendors a clear path through normal workflows and reserves committee time for material decisions.

Use these operating principles:

  • Route vendors by tier, business criticality, data sensitivity, system access, and residual risk.
  • Delegate routine approvals to procurement, security, legal, or business owners within defined thresholds.
  • Bring exceptions, critical vendors, unresolved findings, incidents, and cross-functional conflicts to the committee.
  • Define escalation triggers before the meeting, not during the argument.
  • Time-bound risk acceptances and review them before expiry.
  • Keep records lightweight but consistent.
  • Review the charter when vendor volume, risk appetite, organizational structure, or delegated authority changes.
  • Avoid duplicating procurement, security assessment, legal review, or business-owner responsibilities.

A practical launch path is to start with the charter, members, current high-risk vendor inventory, and open exceptions. Then add the decision matrix, risk acceptance log, recurring agenda, and dashboard reporting once the committee has a working rhythm.

The committee’s purpose is not to add another approval queue. It is to make vendor risk decisions clear, owned, evidenced, and escalated when they exceed the authority of the people in the room. Teams using Ciphrix can connect those decisions to current evidence, reusable controls, risk records, and operational compliance workflows while keeping final governance accountability with the organization.
