Most organizations complete ISO 27001 certification in 3 to 12 months, with well-prepared teams achieving it in as few as 3 to 4 months and complex, multi-site organizations requiring 9 to 12 months or more. The fastest safe route for a small organization with a tight scope and existing security controls runs approximately 3 to 6 months, the common realistic range for mid-size organizations is 4 to 9 months. The single item that money cannot reliably compress is the operating evidence period, which auditors typically expect to span at least three months before Stage 2.
To start the clock, your organization must make two decisions before any other work begins: define the scope of the Information Security Management System (ISMS) and appoint an owner with authority to drive the project.
- Fastest safe route: 3–4 months (small org, tight scope, automation or consultant support)
- Common realistic range: 4–9 months (mid-size, standard scope)
- Extended range: 9–12+ months (large or multi-site organizations, broad scope)
What does the ISO 27001 timeline look like across all phases?

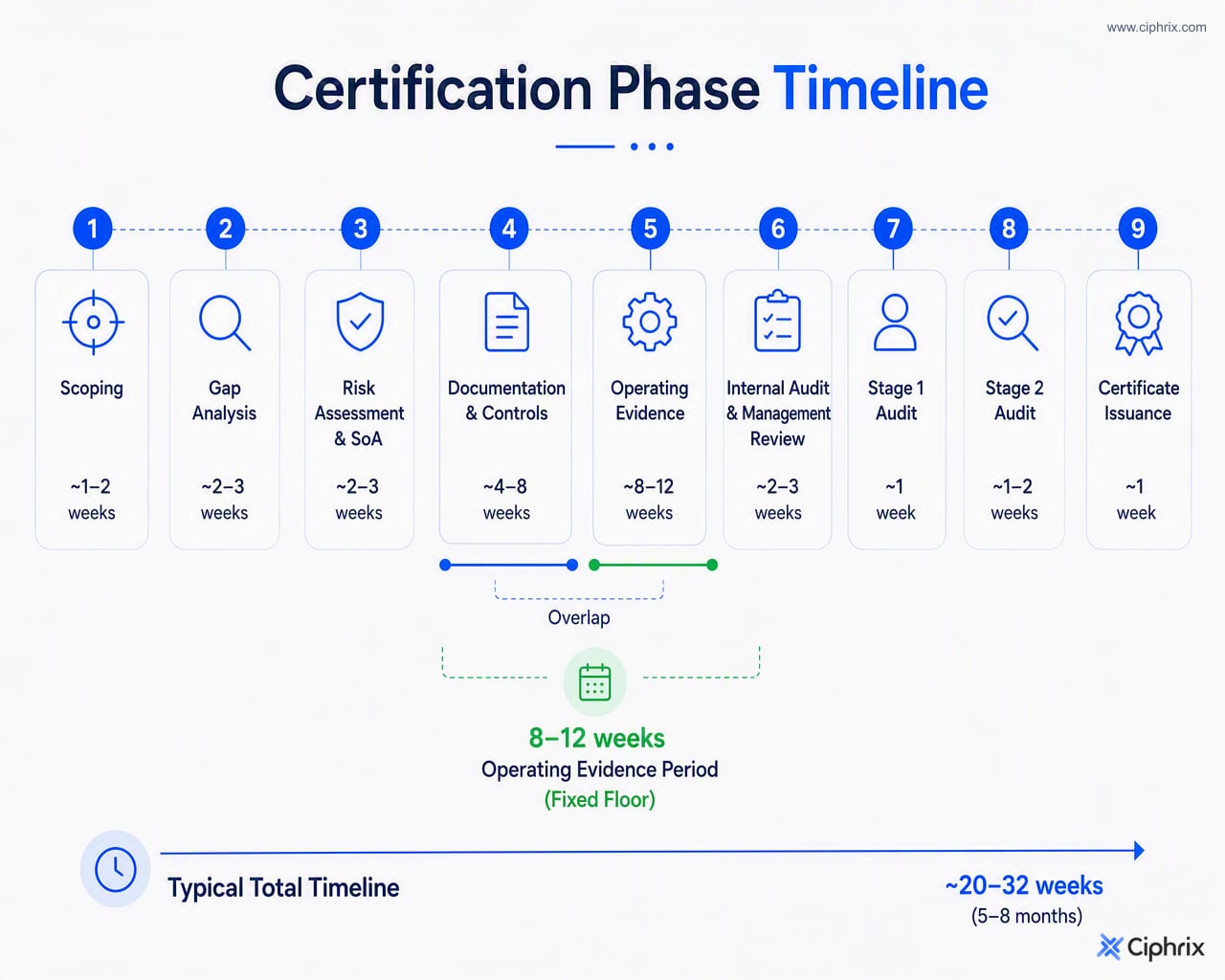

The ISO 27001 certification timeline divides into three broad stages: pre-audit preparation, the certification audit itself, and post-certification maintenance. These stages contain distinct phases that can overlap, and planning those overlaps deliberately is the primary mechanism for shortening total elapsed time.
The table below summarizes each phase, its purpose, and the typical duration range. Phases 3 through 5 can run concurrently once the scope and risk assessment are sufficiently stable.
| Phase | Description | Typical Duration |
|---|---|---|
| Scoping and project setup | Define ISMS boundaries, appoint owner, get leadership sign-off | 2–4 weeks |
| Gap analysis | Assess current controls against ISO 27001 Annex A requirements | 2–4 weeks |
| Risk assessment and SoA | Identify, evaluate, and treat risks; produce Statement of Applicability | 3–5 weeks |
| Documentation and controls | Draft policies, procedures, and evidence mapping | 4–12 weeks |
| Operating evidence period | Generate and collect evidence that controls are functioning | 8–12+ weeks |
| Internal audit and management review | Audit ISMS conformity; management reviews outputs | 2–4 weeks |
| Stage 1 audit (documentation review) | Certification body reviews ISMS documentation | 1–2 days on-site or remote |
| Stage 2 audit (operational verification) | Certification body samples evidence and interviews staff | 2–5 days depending on org size |
| Certification decision and issuance | Certifier reviews findings and issues certificate | 2–4 weeks post-Stage 2 |
Most organizations reach certification in three to twelve months when phases are planned to overlap sensibly. The operating evidence period is the immovable floor: it cannot start until controls are implemented, and it cannot be shortened below the auditor's minimum expectation without creating a nonconformity risk.
Phase 1: Pre-audit preparation steps and per-step time estimates
Pre-audit preparation is where the majority of elapsed time accumulates. Also where planning decisions have the greatest impact on the final certification date.
Step 1: Define scope, appoint ISMS owner, and secure leadership sign-off (weeks 1–3)
Scope definition is the highest-leverage decision in the entire project. A tightly defined scope that covers one product line or one business unit will consistently produce shorter timelines than a scope that spans the entire organization. The scope document must identify the organizational boundaries, information assets included, and interfaces with external parties. Leadership sign-off is a formal requirement under Clause 5.1 (leadership and commitment) and a practical prerequisite for resource allocation.
Deliverables: Scope statement, ISMS project charter, appointed ISMS owner with defined authority.
Step 2: Gap analysis and baseline maturity assessment (weeks 2–5)
A gap analysis maps current controls against the 93 controls in Annex A of ISO/IEC 27001:2022 and the ten clauses of the standard. The output is a prioritized remediation list. Organizations with an existing SOC 2 or NIST CSF program will find significant overlap, which can reduce this phase by one to two weeks. The gap analysis typically requires two to four weeks depending on the number of systems in scope and the availability of existing documentation.
Deliverables: Gap analysis report, prioritized control implementation list.
Step 3: Risk assessment and Statement of Applicability (weeks 4–8)
The risk assessment under Clause 6.1.2 is the technical core of the ISMS. It requires identifying information assets, threats, vulnerabilities, and likelihood/impact ratings, then selecting controls from Annex A to treat accepted risks. The Statement of Applicability (SoA) documents which controls are included, which are excluded, and the justification for each decision. This phase commonly runs three to five weeks. The most frequent pitfall is scope creep in the asset inventory, which can extend this phase by two to three weeks if not managed.
Deliverables: Risk assessment register, risk treatment plan, Statement of Applicability.
Step 4: Documentation, policies, and evidence mapping (weeks 6–16)
Documentation work covers the mandatory documents required by the standard (information security policy, risk assessment procedure, SoA, internal audit procedure, and others) as well as the operational procedures that demonstrate control implementation. For a small organization, this phase may require four to six weeks; for a mid-size organization with multiple departments, eight to twelve weeks is realistic. Ciphrix's risk management capabilities automate a significant portion of policy generation and evidence mapping, which can compress this phase materially.
Deliverables: Complete ISMS documentation set, evidence mapping to Annex A controls.
Step 5: Internal audit and management review (weeks 14–20)
The internal audit is a mandatory requirement under Clause 9.2. It must be conducted by personnel who are independent of the areas being audited and must cover the full scope of the ISMS. The management review under Clause 9.3 follows the internal audit and requires senior leadership to review ISMS performance, audit findings, and resource adequacy. Together, these activities typically require two to four weeks to schedule, conduct, and document.
Deliverables: Internal audit report, nonconformity log, management review minutes.
Stage 1 readiness checklist
Before inviting the certification body for Stage 1, confirm the following artifacts are complete and current:
- Signed scope statement and ISMS policy
- Completed risk assessment and risk treatment plan
- Statement of Applicability with justifications
- Full documentation set covering all applicable Annex A controls
- At least eight to twelve weeks of operating evidence (logs, access reviews, incident records)
- Completed internal audit report with corrective actions closed or in progress
- Management review minutes signed by senior leadership
- Asset inventory current and accurate
Pro Tip: Start generating operating evidence the moment the first control goes live, not after documentation is complete. Evidence generation and documentation work can run in parallel, and this overlap is the single most reliable way to shorten total elapsed time without cutting corners.
Phase 2: What happens during the Stage 1 and Stage 2 certification audits?
The certification audit is conducted by an accredited certification body and happens in two separate stages. Knowing what auditors look at in each stage helps your organization prepare the right evidence packages and avoid common nonconformities.
Stage 1: Documentation review
Stage 1 is mostly a desk review of the ISMS documentation. The auditor checks whether the documented system is designed to meet the requirements of ISO/IEC 27001:2022 and whether the organization is ready to move on to Stage 2. Stage 1 typically takes one to two days and may be done remotely or on-site depending on the certification body's preference and the organization's location.
The auditor will review:
- The scope statement and ISMS policy
- The risk assessment methodology and outputs
- The Statement of Applicability
- Key operational procedures and controls documentation
- Evidence that the internal audit and management review have been completed
Stage 1 produces a findings report identifying any areas of concern. Minor observations are common and do not prevent Stage 2 from going ahead; major nonconformities at Stage 1 require remediation before Stage 2 can be scheduled. Most certification bodies require Stage 2 to be completed within six months of Stage 1.
Stage 2: Operational verification
Stage 2 is the main audit. The auditor samples operational evidence, interviews staff across the scope, and verifies that the ISMS is working as documented. Audit duration scales with organization size:
- Small organizations (under 50 staff in scope): 2–3 audit days
- Mid-size organizations (50–250 staff in scope): 3–4 audit days
- Enterprise organizations (250+ staff or multi-site): 4–5+ audit days
The auditor will sample access control logs, incident records, vulnerability scan results, supplier assessment records, and training completion data. Staff interviews are a standard component; auditors will speak with the ISMS owner, IT staff, and a sample of general employees to check awareness and adherence to policies.
Stage 2 nonconformities are classified as major or minor. Major nonconformities must be closed before certification can be issued. Minor nonconformities require a corrective action plan but do not block issuance. After Stage 2 is completed, the certification body typically issues the certificate within a few weeks after internal review of the audit report and any corrective action evidence.

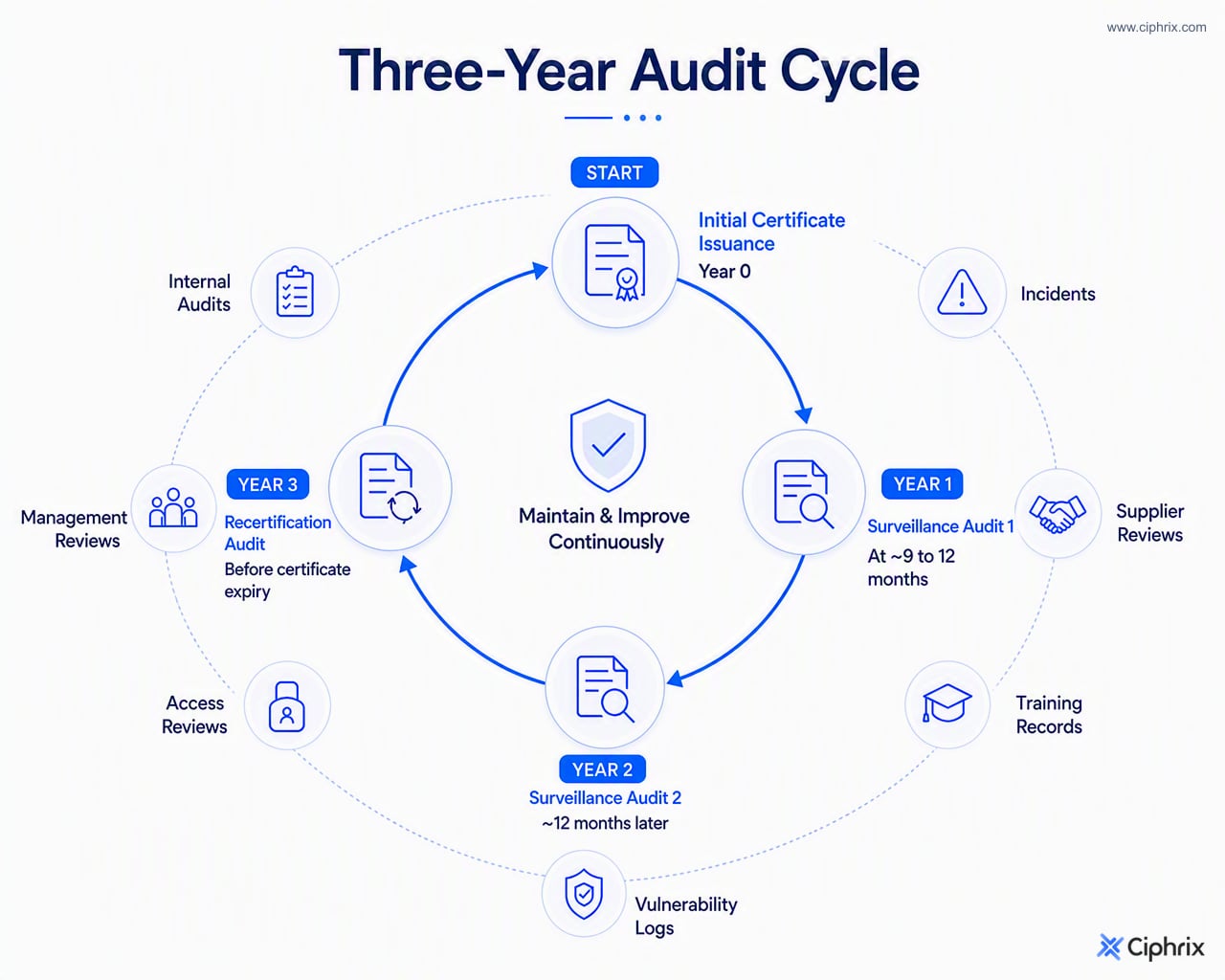

After certification: surveillance audits and the recertification cycle
ISO/IEC 27001:2022 certificates are valid for three years, provided the ISMS is actively maintained. The post-certification schedule is structured and predictable, which makes it straightforward to budget and resource.
Surveillance audit cadence
Surveillance audits are mandatory in years one and two of the certification cycle. They are shorter than the initial audit, typically covering one to two audit days for most organizations, and focus on:
- Changes to the ISMS scope or organizational context
- Progress on corrective actions from the previous audit
- Continued operation of key controls (access management, incident response, supplier reviews)
- Internal audit and management review completion since the last visit
Year 1 surveillance is usually scheduled 9 to 12 months after the initial certificate issuance date. Year 2 surveillance follows approximately 12 months after Year 1.
Recertification
The recertification audit occurs in year three, before the certificate expires. It is more extensive than a surveillance audit and resembles the original Stage 2 in scope and depth. Organizations should begin recertification planning at least three to four months before the certificate expiration date to allow time for scheduling, internal preparation, and any corrective actions.
Ongoing evidence to maintain between audits:
- Internal audit schedule and completed audit reports (at least annual)
- Management review minutes (at least annual, ideally semi-annual)
- Incident log with documented response and closure records
- Access review records (quarterly or semi-annual depending on risk profile)
- Supplier assessment and review records
- Training completion records for all staff in scope
- Vulnerability scan and patch management logs
- Change management records affecting the ISMS
Recertification planning checklist:
- Confirm certificate expiration date and book recertification audit at least four months in advance
- Conduct a full internal audit covering the complete ISMS scope
- Hold a management review addressing all inputs required by Clause 9.3
- Close all open corrective actions from previous surveillance audits
- Update the risk assessment and SoA to reflect any changes in the operating environment
- Prepare an updated evidence package covering the full three-year cycle
What factors speed up or slow down your ISO 27001 timeline?
The range between a three-month and a twelve-month timeline is not random. Five primary drivers determine where your project lands, and each can be assessed before the project begins.
-
Scope breadth. A scope covering a single SaaS product with ten staff will consistently produce shorter timelines than one covering a 500-person organization with multiple business units. Narrow scope is the single most reliable lever for reaching the lower end of the timeline range.
-
Starting security maturity. Organizations with an existing SOC 2 Type II, NIST CSF program, or documented security controls will find that the gap analysis and documentation phases compress significantly. Framework overlaps between SOC 2 and ISO 27001 can reduce duplicate work and shorten the overall schedule by four to eight weeks.
-
Internal bandwidth and dedicated ownership. Projects without a dedicated ISMS owner who has protected time consistently run longer. Part-time ownership adds two to four weeks to most phases simply through scheduling delays and context-switching.
-
Documentation approach. Building policies from scratch takes longer than adapting pre-approved templates or using an automated platform. Template-based or automated documentation can reduce the documentation phase from eight to twelve weeks down to two to four weeks.
-
Certification body lead times. Some certification bodies have Stage 1 and Stage 2 slots booked four to eight weeks out. Booking early, before internal preparation is complete, is a standard practice that avoids adding a month to the end of the project.

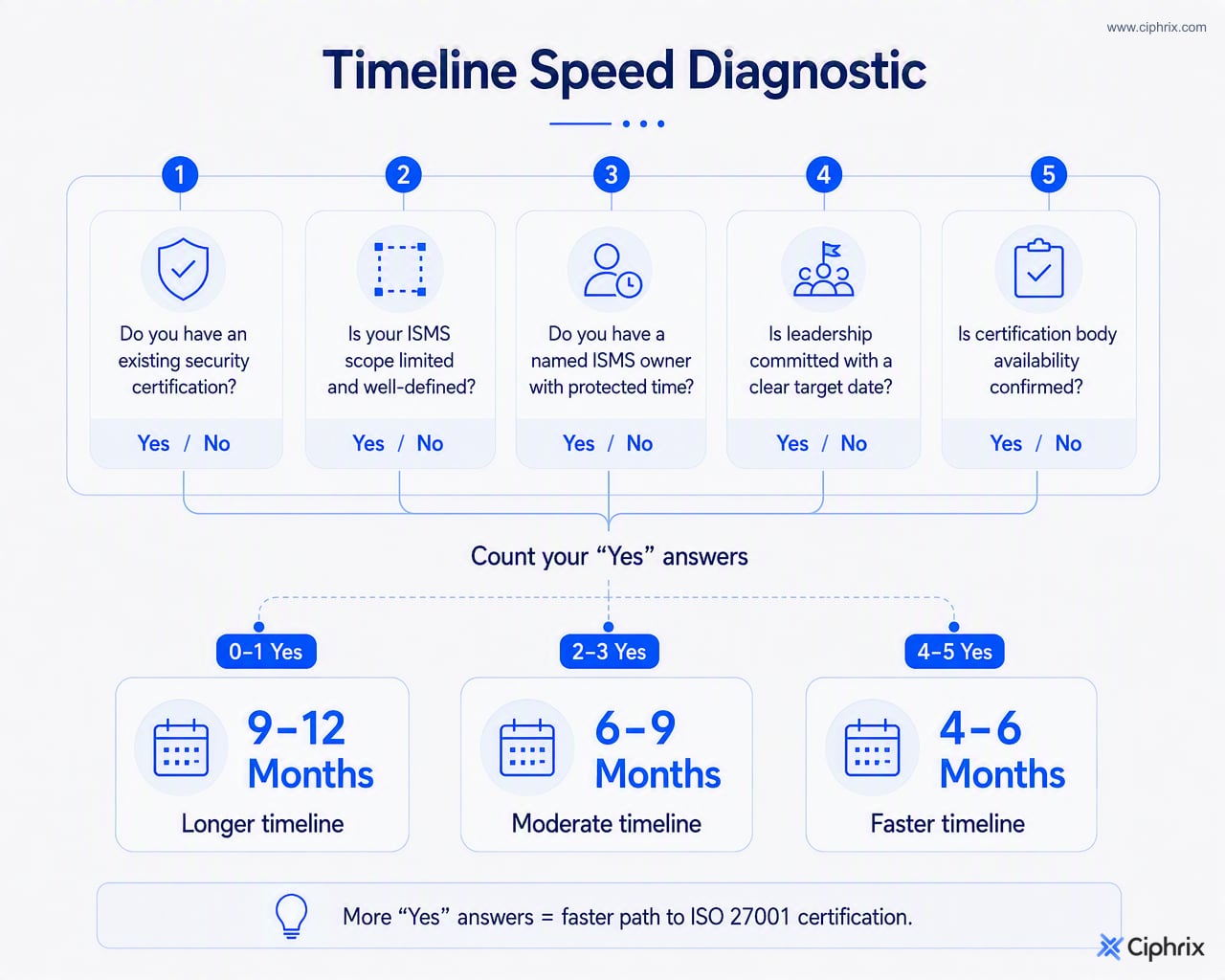

Quick diagnostic questions:
- Does your organization already hold another security certification (SOC 2, FedRAMP, NIST CSF)?
- Is the ISMS scope limited to a single product, team, or business unit?
- Is there a named ISMS owner with at least 50% of their time protected for this project?
- Has leadership formally committed resources and a target certification date?
- Have you contacted at least two certification bodies and confirmed their availability?
If you answer "yes" to four or five of these questions, a 4–6 month timeline is achievable. Two or fewer "yes" answers suggest a 9–12 month plan is more realistic.
Concrete example schedules for small, mid-size, and enterprise organizations
The following templates are designed to be copied into a project tracker and adjusted for organizational context. All three assume ISO/IEC 27001:2022 as the target standard.
Small organization (under 50 staff, single-product scope)
With automation/consultant support: 14–16 weeks
| Milestone | Target Week |
|---|---|
| Scope sign-off and ISMS owner appointed | Week 1 |
| Gap analysis complete | Week 3 |
| Risk assessment and SoA draft | Week 5 |
| Documentation set complete (automated) | Week 7 |
| Operating evidence generation begins | Week 4 (parallel) |
| Internal audit complete | Week 12 |
| Management review complete | Week 12 |
| Stage 1 audit | Week 14 |
| Stage 2 audit | Week 16 |
| Certificate issued | Week 18 |
Without automation (internal-only): 20–26 weeks
The documentation phase extends to weeks 6–14, and evidence generation begins at week 8, pushing Stage 1 to week 20 and Stage 2 to week 22–24.
Mid-size organization (50–250 staff, multi-department scope)
Standard timeline: 24–36 weeks
| Milestone | Target Week |
|---|---|
| Scope sign-off and project charter | Week 2 |
| Gap analysis complete | Week 5 |
| Risk assessment and SoA approved | Week 9 |
| Documentation set complete | Week 16 |
| Operating evidence generation begins | Week 10 (parallel) |
| Internal audit complete | Week 22 |
| Management review complete | Week 24 |
| Stage 1 audit | Week 26 |
| Stage 2 audit | Week 28 |
| Certificate issued | Week 30 |
With consultant or automation support, the documentation phase compresses to weeks 10–14, pulling Stage 1 forward to week 20 and Stage 2 to week 22–26.
Enterprise organization (250+ staff or multi-site)
Extended timeline: 36–52 weeks
Enterprise projects require additional time for stakeholder alignment, multi-site evidence collection, and longer audit windows. The operating evidence period remains 8–12 weeks, but the documentation and risk assessment phases scale with the number of systems and departments in scope. Stage 2 audit duration increases to four to five days. If the organization already holds compliance certifications for SaaS products or other frameworks, the gap analysis and documentation phases can be compressed by mapping existing controls.
Key adaptation notes:
- If scope expands after week 4, add two to four weeks to the risk assessment and documentation phases.
- If leadership sign-off is delayed beyond week 2, push all subsequent milestones by the same number of weeks.
- Book Stage 1 and Stage 2 slots with the certification body no later than week 8 to avoid scheduling delays at the end of the project.
How Ciphrix automation compresses safe timelines: a realistic example
Ciphrix's AI compliance agents automate the phases that traditionally consume the most calendar time: policy generation, risk assessment documentation, evidence collection, and audit preparation. The result is basically a materially shorter path to Stage 1 readiness, without eliminating the controls operation period that auditors require.
A representative example from Ciphrix's customer base illustrates the compression. A SaaS startup with a tight scope and no prior certification used Ciphrix to complete policy generation and evidence mapping in under two weeks, compared to the six to eight weeks typical for manual documentation work. The risk assessment and SoA were completed in approximately one week using automated templates and AI-assisted control mapping. The operating evidence period still ran for approximately twelve weeks, because that floor is set by auditor expectations, not by documentation speed. Total time from kickoff to certificate: approximately 14 weeks. The full customer story provides additional detail on the specific phases and outcomes.
Where automation shortens the timeline:
- Policy and procedure generation: from 6–12 weeks to 1–3 weeks
- Risk assessment and SoA documentation: from 3–5 weeks to 1–2 weeks
- Evidence collection and audit preparation: continuous automated collection vs. manual periodic gathering
- Vendor questionnaire completion: automated, removing a common bottleneck before Stage 1
Where automation cannot compress the timeline:
- Operating evidence period: auditors expect to see controls functioning over time; this floor is typically 8–12 weeks regardless of tooling
- Internal audit and management review: these require human judgment and organizational participation
- Stage 1 and Stage 2 audit scheduling: dependent on certification body availability
Pro Tip: Use the time saved in documentation to start evidence generation earlier. If automation compresses your documentation phase from ten weeks to two, begin evidence collection at week two rather than week ten. That shift alone can move your Stage 2 readiness date forward by six to eight weeks.
How to choose and schedule with a certification body
Selecting the right certification body is a scheduling decision as much as a quality decision. A poor choice adds weeks to the end of the project through scheduling delays, communication gaps, or audit-day estimates that do not match your organization's size.
Selection checklist:
- Confirm accreditation under ISO/IEC 17021-1 (conformity assessment requirements for certification bodies) and ISO/IEC 27006-1 (specific requirements for bodies certifying information security management systems)
- Verify that the certifier has auditors with direct experience in your industry sector
- Confirm multi-site capability if your scope spans more than one location
- Ask for published audit-day estimates for organizations of your size and scope
- Confirm availability for Stage 1 and Stage 2 within your target window before signing a contract
Questions to ask prospective certification bodies:
- What is your current lead time for Stage 1 scheduling?
- Do you offer remote Stage 1 audits, and under what conditions?
- How do you handle major nonconformities identified at Stage 1?
- What is your typical turnaround time from Stage 2 completion to certificate issuance?
- How many audit days do you estimate for an organization of our size and scope?
- What is your policy on Stage 2 rescheduling if we need to delay?
Red flags that predict longer timelines:
- Inability to provide audit-day estimates before contract signature
- Lead times exceeding eight weeks for Stage 1 scheduling
- No published accreditation credentials or refusal to share them
- Auditors without documented experience in information security management systems
- Vague or inconsistent answers about nonconformity handling procedures
To avoid scheduling delays, reserve Stage 1 and Stage 2 slots with your chosen certification body as early as week 6 to 8 of the project, even if your internal preparation is not yet complete. Most certification bodies allow rescheduling with reasonable notice, and holding a slot prevents the common scenario of completing internal preparation only to wait four to six weeks for auditor availability.
Common pitfalls that cause delays and how to recover
The most frequent causes of schedule overruns in ISO 27001 projects are predictable and addressable. Each pitfall below is paired with a concrete remedy and an owner.
-
Vague or expanding scope. Scope creep after the project begins is the most common cause of timeline extension. Remedy: freeze the scope document after leadership sign-off in week 1 or 2, and require a formal change request with timeline impact assessment for any proposed expansion. Owner: ISMS owner and project sponsor.
-
Under-resourced ISMS owner. A part-time owner managing competing priorities will consistently miss phase deadlines. Remedy: negotiate at least 50% protected time for the ISMS owner before the project begins, or engage an external consultant to supplement capacity. Owner: executive sponsor.
-
Late evidence generation. Starting evidence collection only after documentation is complete adds eight to twelve weeks to the project. Remedy: begin evidence generation in parallel with documentation, as noted in the readiness checklist above. Owner: ISMS owner and IT operations.
-
Slow leadership sign-off. Management review and policy approvals that require multiple revision cycles delay the internal audit and Stage 1 readiness. Remedy: schedule leadership review sessions in advance with fixed deadlines, and present documents in summary format with clear approval requests. Owner: ISMS owner.
-
Booking audits too late. Waiting until internal preparation is complete before contacting the certification body adds four to eight weeks. Remedy: contact at least two certification bodies in week 4 to 6 and reserve provisional slots. Owner: ISMS owner or project manager.
-
Audit finding escalation. A major nonconformity at Stage 1 or Stage 2 can delay certification by four to eight weeks. Remedy: conduct a pre-Stage 1 internal readiness review using the checklist in Phase 1 above, and close all open corrective actions before inviting the auditor. If a major nonconformity does occur, assign a dedicated remediation owner and submit corrective action evidence within the certifier's stated window.
How long does staff training take in the ISO 27001 preparation schedule?
Staff training and security awareness are mandatory requirements under Clause 7.2 (competence) and Clause 7.3 (awareness) of ISO/IEC 27001:2022. They are also also a common area of nonconformity at Stage 2, because organizations frequently treat training as a final-week activity rather than an ongoing program.
Realistic time estimates for training activities within the preparation schedule:
-
ISMS owner and core team training (ISO 27001 fundamentals, risk assessment methodology, internal auditor training): 2–4 weeks, typically completed during the gap analysis and risk assessment phases. Internal auditor training specifically requires sufficient lead time before the internal audit is conducted.
-
General staff security awareness training: 2–4 weeks to design, deploy, and collect completion records. For organizations using a learning management system, deployment can begin as early as week 6 and run concurrently with documentation work.
-
Role-specific training (IT administrators, incident responders, supplier managers): 1–3 weeks per role group, scheduled based on when the relevant controls go live.
The key scheduling principle is that training completion records are operating evidence. Starting training early means those records are available and dated well before Stage 2, which strengthens the evidence package. Auditors will ask to see completion records, training content, and evidence that staff can articulate the organization's information security policy and their own responsibilities under it.
For organizations managing multiple frameworks simultaneously, training content can often be consolidated. An awareness module covering ISO 27001 data classification requirements will frequently satisfy parallel requirements under HIPAA or SOC 2, reducing total training development time.
How does ISO 27001 fit alongside other certifications and organizational projects?
Organizations rarely pursue ISO 27001 in isolation. The certification timeline intersects with product development cycles, other compliance programs, and organizational change initiatives, and managing those intersections deliberately prevents schedule conflicts.
Framework overlap and time savings. Organizations that already hold SOC 2 Type II will find that a significant portion of the ISO 27001 control set is already implemented and evidenced. The comparison between ISO 27001 and SOC 2 shows substantial overlap in access control, incident management, and change management requirements. In practice, this overlap can reduce the gap analysis phase by one to two weeks and the documentation phase by two to four weeks, because existing policies can be adapted rather than written from scratch.
Organizations managing ISO 22301 (business continuity) alongside ISO 27001 benefit from shared documentation structures and overlapping management system requirements. Ciphrix supports ISO 22301 compliance alongside ISO 27001, letting organizations manage both frameworks within a single platform and avoid duplicating evidence collection.
Sequencing with organizational projects. Major technology migrations, acquisitions, or organizational restructuring during the ISMS implementation period are a significant risk to the timeline. A cloud migration that changes the asset inventory mid-project can invalidate portions of the risk assessment—or, more accurately, make parts of it stale—and require rework. The practical guidance is to either complete the migration before beginning the ISO 27001 project or explicitly exclude the migrating systems from the initial scope and add them in a subsequent scope extension after certification.
Budget and resource planning. ISO 27001 projects compete for the same internal resources as product development and operational initiatives. Building the certification timeline into the annual planning cycle, with explicit resource allocations for the ISMS owner and supporting staff, is more reliable than treating it as a parallel workstream that fits around other priorities.
What are the minimum audit durations required by accreditation standards?
The minimum audit durations for ISO 27001 certification are not arbitrary. They are derived from ISO/IEC 27006-1, which specifies the requirements for certification bodies conducting ISMS audits, and from the International Accreditation Forum (IAF) Mandatory Document MD 5, which provides guidance on audit time calculations.
Under these standards, audit duration is calculated based on the number of employees within the scope, the complexity of the ISMS, and the number of sites. The resulting figure is expressed in audit-person-days (APDs).
Key minimum requirements:
-
Stage 1 audit: Typically one-third of the total initial certification audit time, with a minimum of one audit day for small organizations. Stage 1 may be conducted remotely in most cases.
-
Stage 2 audit: The substantive portion of the initial certification audit. For a small organization with fewer than 10 employees in scope, the minimum is typically 1.5 to 2 audit days. For organizations with 50 to 250 employees in scope, the minimum rises to 3 to 4 audit days. These figures represent the floor; certification bodies may allocate additional days based on scope complexity.
-
Surveillance audits: IAF MD 5 specifies that the total surveillance audit time over the three-year cycle must be at least one-third of the initial certification audit time. In practice, each annual surveillance visit typically runs one to two audit days for small to mid-size organizations.
-
Recertification audits: Recertification audit time is typically set at the same level as the original Stage 2 audit, though certification bodies may adjust based on the maturity of the ISMS and the findings history from surveillance visits.
These minimums are enforced by accreditation bodies such as ANAB (ANSI National Accreditation Board) in the United States. A certification body that proposes audit durations materially below these thresholds is a red flag, as it may indicate inadequate accreditation oversight or a willingness to issue certificates without sufficient audit rigor.
What the ISO 27001 timeline reveals about how compliance actually works
The most consistent observation from ISO 27001 delivery practice is that organizations underestimate the operating evidence period and overestimate how much speed can be purchased. Documentation can be accelerated with templates and automation. Risk assessments can be structured efficiently with the right methodology. But the period during which controls must demonstrably function, generating dated logs, completed reviews, and closed incidents, is set by auditor expectations rooted in accreditation standards, not really by project management skill.
The practical implication is that the fastest safe timeline is not the one with the shortest documentation phase. It is the one where evidence generation starts earliest. An organization that begins collecting access review records, patch logs, and training completions in week 4 of a 16-week project will arrive at Stage 2 with a stronger evidence package than one that completes documentation in week 12 and then has to wait for evidence to accumulate.
A second observation worth stating plainly: scope decisions made in week 1 determine more of the final timeline than any subsequent choice. Organizations that define a tight, defensible scope and resist the pressure to expand it mid-project consistently reach the lower end of the timeline range. Those that allow scope to grow after the risk assessment is underway typically add four to eight weeks for every significant expansion, in practice.
A practical sanity check for any project plan:
- Is the operating evidence period at least eight weeks long, with a start date before documentation is complete?
- Is the scope document signed and frozen before the risk assessment begins?
- Are Stage 1 and Stage 2 slots reserved with the certification body before week 10?
- Does the ISMS owner have protected time confirmed in writing?
- Is the internal audit scheduled at least four weeks before the Stage 1 date?
If any of these conditions is not met, the project plan carries a scheduling risk that should be addressed before work gets too far.
Key Takeaways
Most organizations complete ISO 27001 certification in 3 to 12 months, with the operating evidence period of 8 to 12 weeks serving as the fixed floor that no amount of automation or consulting can eliminate.
| Point | Details |
|---|---|
| Total timeline range | 3–4 months for small orgs with tight scope; 4–9 months for mid-size; 9–12+ months for enterprise. |
| Operating evidence floor | Auditors expect at least 8–12 weeks of evidence that controls are functioning before Stage 2. |
| Scope decision impact | Defining a tight, frozen scope in week 1 is the single most reliable lever for reaching the lower end of the range. |
| Post-certification cycle | Surveillance audits are required in years 1 and 2; recertification is required in year 3 before the certificate expires. |
| Ciphrix acceleration | Ciphrix automates policy generation, risk assessment, and evidence collection, compressing documentation phases from weeks to days and moving Stage 1 readiness earlier. |
Ciphrix cuts weeks from your ISO 27001 certification schedule
The phases that consume the most calendar time in a manual ISO 27001 project are policy generation, risk assessment documentation, and evidence collection. Ciphrix's AI compliance platform automates all three, compressing the documentation and risk assessment phases from a combined 8 to 17 weeks down to 2 to 5 weeks for most organizations. The operating evidence period still runs its required course, but your team arrives at it weeks earlier, which moves the Stage 2 readiness date forward by the same margin.
For startups and mid-market organizations managing tight timelines, Ciphrix for startups provides pre-built ISO 27001 policy templates, automated evidence collection, and continuous compliance monitoring that keeps the ISMS audit-ready between surveillance visits, not just at certification time. Enterprise teams with multi-framework requirements can manage ISO 27001 alongside SOC 2, HIPAA, and other frameworks within a single platform, eliminating duplicate evidence collection across programs.
To see how Ciphrix maps to your specific timeline and scope, request a demo at Ciphrix.
Sources
The following sources support the timeline figures and scheduling guidance in this article and are recommended for further reading and planning validation.
