Conduct a Data Protection Impact Assessment (DPIA) whenever processing is likely to create a high risk to the rights and freedoms of natural persons under Article 35 of the GDPR. The next step is simple: run a short screening checklist, document the outcome, and if the screening flags high risk, start a full DPIA before processing begins. The EDPB's 2026 DPIA template and ICO guidance both provide structured starting points; Ciphrix can automate evidence collection and template enforcement throughout the process.
Before starting a full DPIA, confirm at least one of the following triggers applies:
- Large-scale processing of special category data (health, biometric, genetic, racial, religious)
- Systematic and large-scale profiling or automated decision-making with legal or similarly significant effects
- Systematic monitoring of publicly accessible areas at large scale
- Processing that matches or combines datasets in ways that exceed individuals' reasonable expectations
- New technologies or novel uses of existing technologies that introduce uncertain risk profiles
What is a DPIA and why does the GDPR require one?
A DPIA is a process to systematically analyze, identify, and minimize data protection risks before a processing activity begins. The ICO defines it as a tool for accountability under the GDPR, requiring controllers to document the nature, scope, context, and purposes of processing alongside an assessment of necessity, proportionality, and risk to individuals' rights and freedoms.
The legal anchor is Article 35 GDPR, controllers are required to carry out a DPIA when processing is likely to result in high risk, and supervisory authorities — including the EDPB and national Data Protection Commissions — expect the process to be documented, traceable, and reviewed over time.
DPIAs also serve a practical governance function beyond regulatory compliance. They force cross-functional teams to articulate processing purposes, data flows, and risk controls in a single record, which becomes the primary evidence artifact during supervisory audits. For US-based organizations subject to GDPR (see the next section), that record is often the first document a supervisory authority requests.
When is a DPIA required, and does it apply to US organizations?

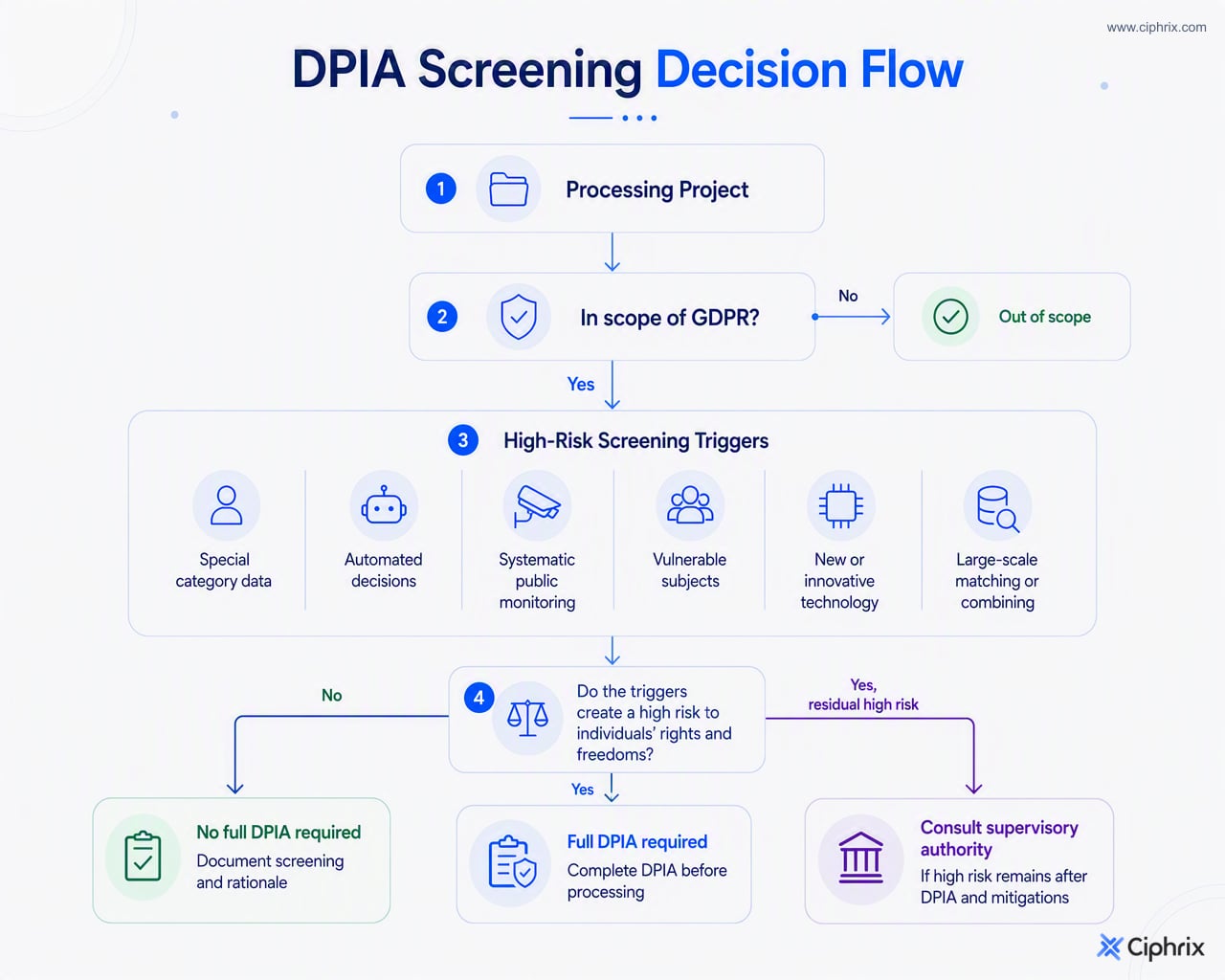

The ICO's 7-step DPIA process begins with a screening step that determines whether a full DPIA is mandatory. Run this screening before any significant processing project begins and record the outcome either way.
Screening checklist — flag high risk if any item applies:
- Processing involves profiling or automated decision-making with legal or similarly significant effects on individuals
- Processing involves special category data at scale (health, biometric, genetic, criminal conviction data)
- Processing involves systematic monitoring of individuals in publicly accessible spaces
- A new technology is being deployed whose privacy implications are not yet fully understood
- Processing could result in denial of service, financial harm, or reputational damage to individuals
- Data subjects are vulnerable (children, patients, employees under power imbalance)
- Processing involves large-scale data matching or combining datasets from multiple sources
US applicability. GDPR applies to any organization that offers goods or services to individuals in the EU/EEA, or that monitors the behavior of EU-based individuals — regardless of where the organization is incorporated. A US SaaS company with EU customers, a US healthcare provider with EU patient data, or a US employer with EU-based staff all fall within GDPR's territorial scope under Article 3. Those organizations must conduct DPIAs when the screening criteria above are met. US privacy frameworks such as CCPA do not require DPIAs by name, but many US organizations align their Privacy Impact Assessment (PIA) processes with GDPR DPIA requirements to satisfy both regimes simultaneously. The DPIA vs. PIA distinction is basically structural: a DPIA is a GDPR-specific legal obligation with defined content requirements, while a PIA is a broader, often voluntary risk assessment framework common in US federal practice.
How to carry out a DPIA: a practical step-by-step workflow

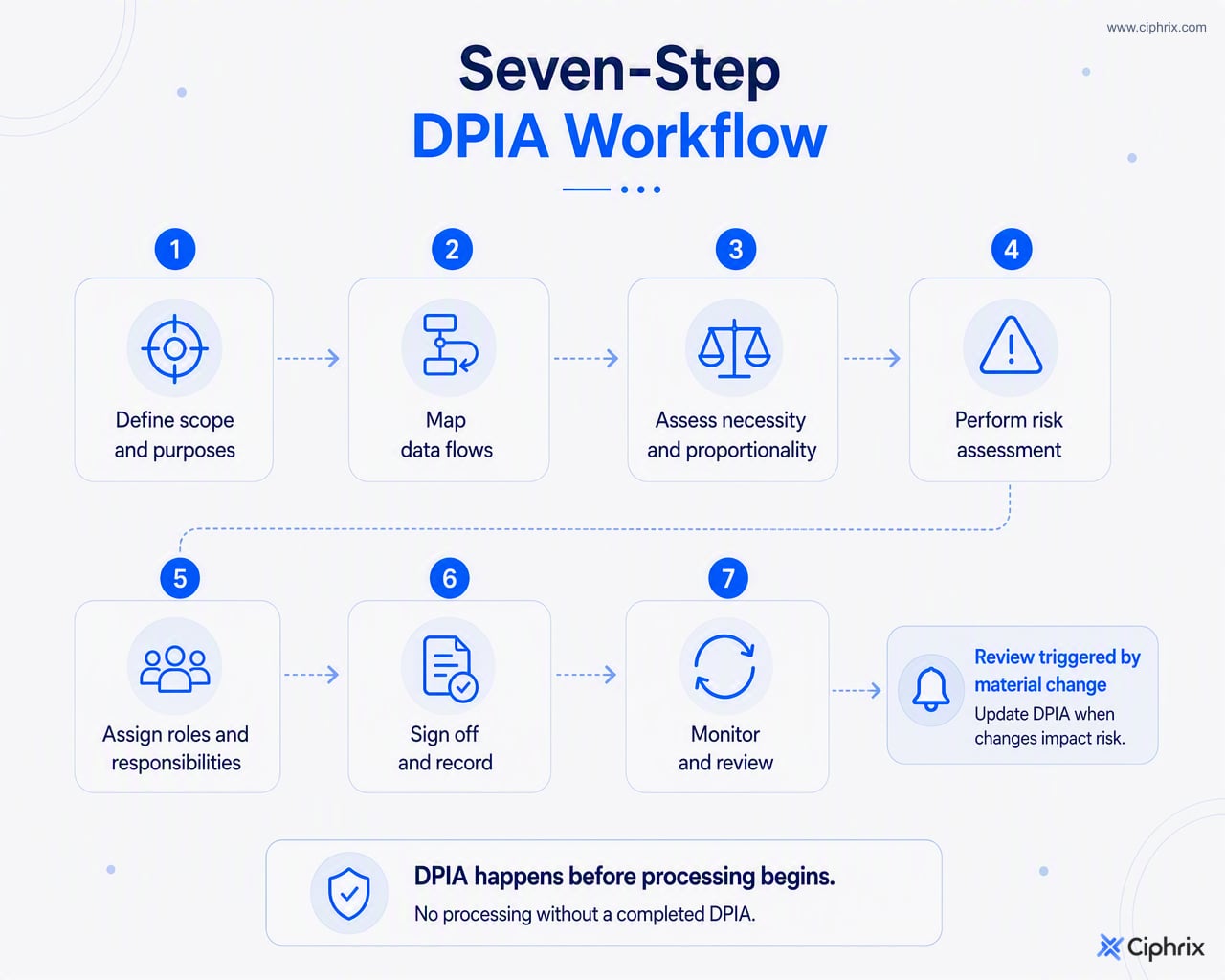

The ICO's structured process and the Loughborough University DPIA workflow both map a consistent sequence that supervisory authorities recognize. The steps below align with that sequence and the EDPB 2026 template structure.
Step 1: Define scope and processing purposes. Document the nature, scope, context, and purposes of processing. Before any design decisions are finalized. This is the single most important step — vague scope produces a DPIA that supervisory authorities cannot evaluate.
Step 2: Map data flows. Identify categories of data subjects, data types, volumes, retention periods, third-party processors, and international transfer profiles. Attach an architecture diagram or data flow map as evidence.
Step 3: Assess necessity and proportionality. Confirm that the processing is limited to what is necessary for the stated purpose, that the lawful basis is identified and documented, and that data minimization controls are in place.
Step 4: Perform the risk assessment. Assess each identified risk by likelihood and severity. Produce a risk register with residual risk ratings after mitigations are applied.
| Risk | Likelihood (1–3) | Severity (1–3) | Inherent Score | Mitigation | Residual Score |
|---|---|---|---|---|---|
| Unauthorized access to health records | 2 | 3 | 6 | Encryption at rest and in transit, access controls, audit logs | 2 |
| Re-identification of pseudonymized data | 2 | 3 | 6 | Strict data minimization, aggregation thresholds | 3 |
| Inaccurate profiling leading to denial of service | 3 | 3 | 9 | Human review step, accuracy testing, appeal mechanism | 4 |
| Data subject unable to exercise rights | 1 | 2 | 2 | Rights request workflow, documented response SLA | 1 |
Step 5: Assign roles and responsibilities. Document the controller, DPO, security lead, legal counsel, and project owner. A RACI matrix prevents accountability gaps during audit.
Step 6: Sign off and record. The DPO reviews and records their advice. The controller signs off. The completed DPIA is stored in the compliance record with version control.
Step 7: Monitor and review. Schedule a review date. Trigger a reassessment whenever the processing purpose, technology, or risk profile changes materially.
Pro Tip: Before closing the risk register, ask the engineering team to demonstrate — not just describe — each technical mitigation. A control that exists in documentation but has not been tested in the production environment does not reduce residual risk for supervisory purposes.
Practical DPIA template: the fields every report must include
The EDPB's 2026 template explainer recommends reviewing the full template before starting to complete it, to ensure completeness and traceability. The minimum structured fields supervisory authorities expect are listed below.
Required DPIA report fields (copyable checklist):
- Processing overview: name, version, date, controller identity
- Technical sheet: data categories, data subjects, volumes, retention, transfers
- Team and RACI: controller, DPO, security lead, legal, project owner
- Legal bases: identified lawful basis per processing purpose, with documentation
- Necessity and proportionality assessment: data minimization, purpose limitation, storage limitation
- Risk assessment: risk register with likelihood × severity scoring and residual ratings
- Mitigation measures: specific controls, responsible owner, implementation status
- Monitoring and review: scheduled review date, trigger conditions for reassessment
- DPO advice: recorded opinion, date, and whether advice was followed
- Version log: change history with dates and authors
| DPIA Field | Evidence / Document to Attach |
|---|---|
| Data flow description | Architecture diagram, data flow map |
| Legal basis | Privacy notice, contract clauses, legitimate interest assessment |
| Third-party processors | Processor agreements, sub-processor list, transfer impact assessment |
| Technical controls | Security policy, encryption specification, access control matrix |
| Risk register | Completed risk register with residual scores |
| DPO advice | Written DPO opinion or sign-off record |
| Review schedule | Calendar entry or project governance record |
When to consult a supervisory authority and what to prepare
The legal trigger for prior consultation is a residual high risk that cannot be mitigated to an acceptable level. ICO guidance and Article 36 GDPR both require controllers to consult the competent supervisory authority before processing begins in that scenario. The Irish Data Protection Commission reinforces this obligation and sets out the documentation controllers must provide for the process.
Documents to prepare for supervisory consultation:
- Completed DPIA report (all fields populated, version-controlled)
- Risk register with residual risk ratings and rationale for why risk cannot be further reduced
- Mitigation plan with implementation timelines and responsible owners
- Written DPO advice and whether the controller followed it
- Technical architecture diagrams and data flow maps
- Processor agreements and transfer safeguards (Standard Contractual Clauses or equivalent)
Supervisory authorities typically respond within a standard regulatory response time frame, which can be extended for complex cases under Article 36(2). Document the submission date, any authority correspondence, and the final outcome in the DPIA version log. If the authority raises objections, record the controller's response and any additional mitigations adopted for the record.
Concrete high-risk processing examples and suggested mitigations
The DPC guidance and the CSU Ohio law blog both provide practical framing for common high-risk scenarios. The examples below are sector-relevant for US organizations operating under GDPR.
AI-driven credit scoring or profiling. Automated decisions with legal or similarly significant effects require a human review mechanism, an accuracy-testing protocol, and a documented appeal process. Processor assistance clauses must require the vendor to support rights requests and audits.
Large-scale biometric identification in public spaces. Mitigations include strict purpose limitation (no secondary use), defined retention periods (typically for operational data), and a data protection by design review of the capture system. Financial services organizations should also review sector-specific banking privacy obligations when deploying biometric authentication.
Employee health screening data. Special category data processed under Article 9 requires explicit consent or a specific legal basis, strict access controls limited to occupational health personnel, and a documented retention schedule. Combining health data with performance data for automated HR decisions triggers an additional profiling risk that must be assessed separately.
Behavioral tracking across digital platforms. Cookie-based or device-fingerprint tracking at scale requires a lawful basis review (consent is typically required), a data minimization assessment, and a transfer impact assessment if data flows to US-based processors.
Common pitfalls that render mitigations ineffective:
- Documenting encryption as a control without specifying the algorithm, key management process, or testing evidence
- Listing "access controls" without an access matrix showing who has access to what and why
- Recording a review date without assigning an owner responsible for triggering the review
- Treating processor contractual clauses as sufficient mitigation without verifying the processor's actual security posture
How to integrate DPIAs into project and governance lifecycles
DPIAs must begin at the earliest possible design phase, not after a system is built. The ICO's accountability guidance is explicit: a DPIA completed after processing has started does not satisfy the Article 35 obligation.

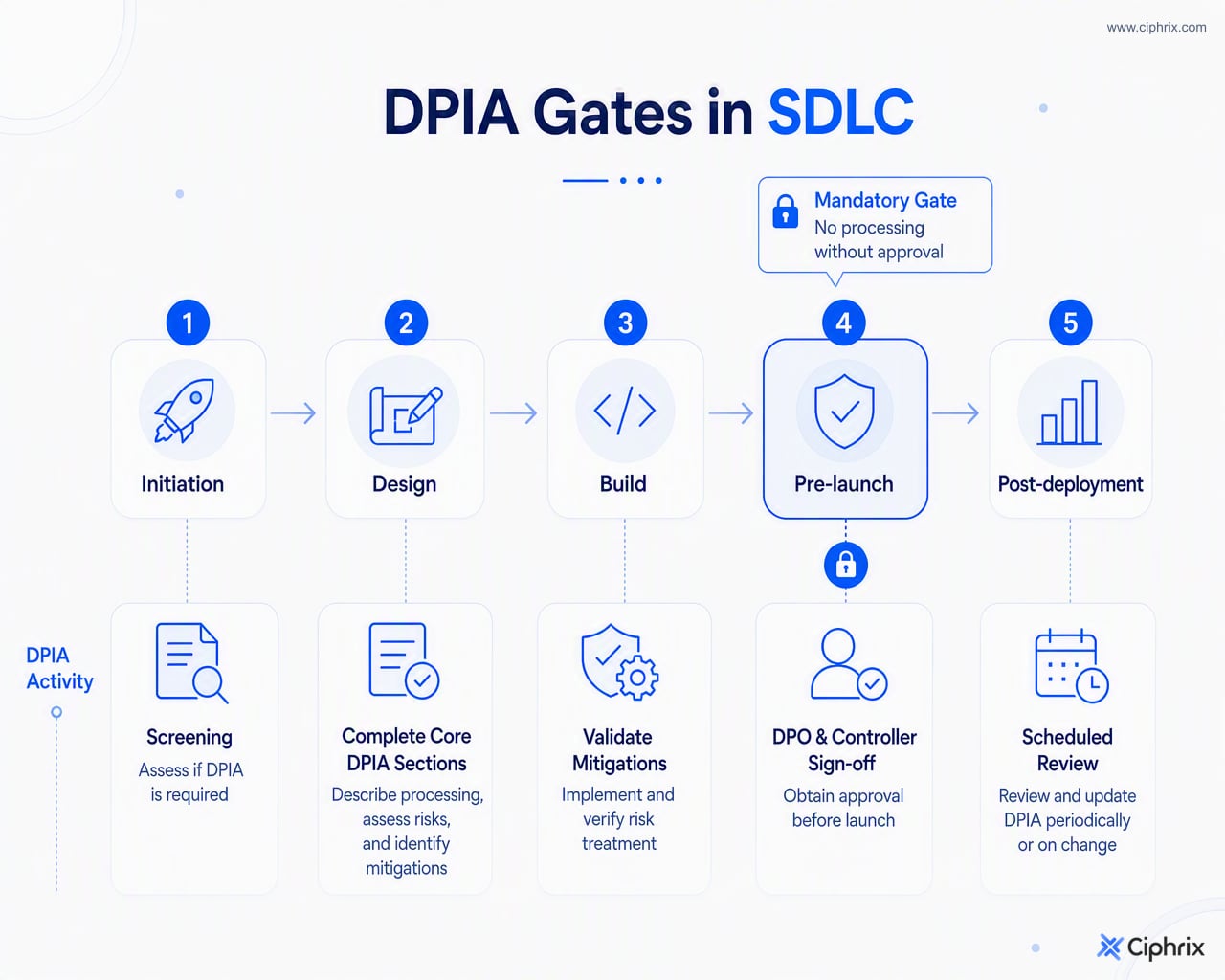

Embedding DPIAs in the SDLC:
| Project Phase | DPIA Activity | Owner |
|---|---|---|
| Initiation / discovery | Run screening checklist; document decision | Privacy lead |
| Design | Complete DPIA sections 1–5 (scope, flows, legal basis, necessity, risk) | DPO + project lead |
| Build | Validate technical mitigations with engineering; update risk register | Security lead |
| Pre-launch | DPO sign-off; controller approval; version log finalized | DPO + controller |
| Post-deployment | Scheduled review (minimum annually or on material change) | Privacy lead |
Versioning and audit readiness. Each DPIA version should carry a date, author, change description, and approval status. Retain completed DPIAs for the duration of the processing activity plus a minimum of three years to cover supervisory inquiry windows. Present findings to senior decision-makers as a one-page risk summary with residual risk ratings and open mitigations — not the full technical report, which belongs in the compliance record.
Which frameworks and tools should you use for DPIA work?
Authoritative templates come first. The EDPB 2026 template is the primary reference for field structure and supervisory expectations. The ICO's DPIA guidance pages provide the most detailed procedural checklists in English. National DPC guidance (Irish DPC, French CNIL, German DSK) adds jurisdiction-specific interpretation where the lead supervisory authority matters.
Tooling categories and what each saves:
- Templated checklists: Reduce field omission errors and ensure EDPB/ICO alignment; save drafting time but require custom risk analysis to be added manually.
- Risk registers with scoring: Automate likelihood × severity calculations and flag residual high-risk items; save calculation time and reduce inconsistency across assessors.
- Evidence collection automation: Pull security policies, access logs, processor agreements, and architecture diagrams into a centralized record; saves significant manual retrieval time during audits.
- Workflow and RACI tools: Route DPIA sections to the correct owner, track completion status, and generate sign-off records; reduce coordination overhead in large teams.
Over-reliance on canned templates without customization is a consistent failure mode. Supervisory authorities can identify a generic template that has not been tailored to the specific processing activity — vague risk descriptions and boilerplate mitigations are the clearest signals. Every DPIA requires qualitative analysis specific to the project's nature, scope, context, and purposes. Tooling facilitates that analysis; it does not replace it.
What privacy leads get wrong about DPIAs in practice
The most persistent misconception is that a DPIA is a documentation exercise rather than a risk management process. Teams that treat it as a form to fill in — or, more accurately, a form to get out of the way — rather than a structured analysis to conduct produce DPIAs that satisfy the letter of Article 35 while failing its purpose. Supervisory authorities notice the difference immediately: a DPIA with generic risk descriptions and untested mitigations is treated as evidence of inadequate accountability, not compliance.
Getting senior buy-in requires translating DPIA findings into business risk language. A residual high-risk rating on a profiling system means the organization cannot lawfully process until the risk is reduced or the supervisory authority is consulted. That is a project gate, not a privacy team concern — or not just a privacy team concern. Framing it that way — as a condition precedent to launch — secures attention from decision-makers who would otherwise treat the DPIA as a back-office task.
Time-boxed DPIA sprints work well for organizations under project pressure. A focused two-day sprint with the DPO, security lead, and project owner present can complete sections 1–5 of the EDPB template for a mid-complexity processing activity. The remaining sections (mitigation validation, sign-off, monitoring) follow as engineering confirms controls. The key discipline is not to close the DPIA until technical mitigations have been verified in the production environment, not just written down — documented in a policy.
Pro Tip: Run a small-scale rollout before full deployment for any processing activity involving automated decision-making. Monitor outputs for accuracy and bias indicators during that period, and record the findings in the DPIA risk register as evidence that mitigations are functioning as designed.
Ciphrix reduces the manual burden of DPIA evidence collection
Producing an audit-ready DPIA requires assembling evidence across security, legal, engineering, and privacy functions — a process that consumes significant time when managed manually. Ciphrix's AI compliance agents automate evidence collection, enforce EDPB-aligned template fields, and maintain version-controlled DPIA records that supervisory authorities can review without further preparation.
The platform maps DPIA risk register outputs directly to compliance risk management workflows, assigns RACI ownership, and generates audit reports that reflect the current state of each mitigation. What Ciphrix does not replace is the human risk judgment at the center of every DPIA — the qualitative analysis of nature, scope, context, and purposes that supervisory authorities evaluate most closely. That judgment belongs to your DPO and privacy team; Ciphrix handles the evidence infrastructure around that judgment.
Organizations managing GDPR alongside ISO 27001, SOC 2, or HIPAA can align DPIA outputs with those compliance frameworks in a single platform, reducing duplication across programs. To see how Ciphrix fits your organization's compliance structure, visit Ciphrix or explore the enterprise compliance platform.
